Category: Plant Design & Engineering

Technical insights on industrial plant layout, system design, equipment selection, and engineering considerations for thermal, biomass, and process plants.

  • Plant Interface Coordination: Key Practices for EPC Projects

    Plant Interface Coordination: Key Practices for EPC Projects

    Most project problems do not come from any single discipline doing its job badly. They come from the gaps between disciplines. Piping is designed correctly. Structural steel is designed correctly. But the pipe does not fit through the opening in the steel. The electrical cable tray clashes with the ductwork. The vendor’s equipment arrives with connections that do not match the site’s utilities. Interface coordination is the discipline of managing these gaps.

    At EPC Partners Inc., interface coordination has been a core part of our work across a wide range of plant projects: geothermal power plants in Kenya, Indonesia, and Iceland; large-scale desalination facilities in the UAE and Saudi Arabia; thermal power plants in Vietnam and Bangladesh; and water treatment plants in Vietnam and Kuwait. Each project has presented different interface challenges, and each has reinforced the same lesson: interface coordination is not just about avoiding clashes. It is about ensuring that disciplines, contractors, and systems work together as a whole.

    Our interface coordination work has ranged from geothermal projects in Kenya and Indonesia, where steam gathering and power plant interfaces were critical, to desalination projects in the Gulf, where coordination between marine, process, and electrical contractors was essential.

    This article covers the key practices in plant interface coordination, drawing on our experience supporting projects across Asia, the Middle East, Africa, and Europe.

    What Is Interface Coordination?

    Interface coordination is the discipline of identifying, defining, and controlling the points of interaction between different parts of a project.

    An interface is any point where:

    • Two disciplines meet (e.g., mechanical and electrical).
    • Two contractors meet (e.g., civil contractor and mechanical contractor).
    • Two systems meet (e.g., process and control systems).
    • Two organizations meet (e.g., owner and EPC contractor).
    • Two phases meet (e.g., construction and commissioning).
    • New works meet existing facilities (e.g., tie-ins to live plant systems).
    • The plant meets external parties (e.g., grid operators, utilities, port authorities, and regulators).

    Interface coordination ensures that these points are defined, documented, and controlled.

    Interface coordination is closely related to interface management, which covers the wider framework of registers, agreements, and governance. In practice the two overlap: management sets the framework, and coordination is the day-to-day work of making interfaces function across disciplines and contractors.

    Why Interface Coordination Matters

    Interface failures are among the most common causes of project problems.

    Factor Impact of Good Interface Coordination Impact of Poor Interface Coordination
    Schedule Work proceeds without clashes Work stops at interfaces
    Cost Rework avoided Rework and added cost
    Quality Interfaces correctly designed and built Misalignment, leaks, failures
    Safety Interfaces assessed for safety Safety hazards at interfaces
    Coordination Disciplines work together Disciplines blame each other
    Disputes Responsibilities clear Disputes over responsibility

    For small to medium-scale industrial plants, interface coordination determines whether the project runs smoothly or gets bogged down in conflicts.

    Interface Identification

    Interface identification is the first step in interface coordination.

    Interface identification methods:

    • Review project scope: What scopes are involved, and where do they meet?
    • Review contracts: What are the scope boundaries and responsibilities?
    • Review drawings: Where do disciplines and systems connect? P&IDs, single-line diagrams, and general arrangement drawings are especially useful.
    • Review the WBS: Where do work packages interface?
    • Review vendor packages: Where does skid-mounted or packaged equipment connect to the plant?
    • Workshops: Bring together disciplines and contractors to identify interfaces.
    • Interface register: Document identified interfaces.

    Interface identification should be comprehensive. Missing an interface is worse than identifying too many. It should also be repeated at key milestones, because new interfaces appear as design develops, vendors are selected, and contractors are appointed.

    At our geothermal projects in Kenya (Olkaria I Unit 6, 83 MW) and Indonesia (Muara Laboh, 85.2 MW), interface identification focused on the points where the steam gathering system met the power plant, and where the drilling and civil works met the mechanical and electrical systems. In Iceland (Theistareykir, 2×45 MW), interface identification considered the seismic and environmental conditions of the site.

    Interface Register

    Interface register for tracking interfaces in EPC projects

    The interface register is the central document for interface coordination.

    Field Description
    Interface ID Unique identifier
    Description What the interface is
    Parties involved Who is on each side of the interface
    Type Physical, functional, organizational, etc.
    Status Open, agreed, closed
    Responsible party Who owns the interface
    Due date When the interface must be resolved
    Documents Relevant drawings, specifications, agreements
    Issues Open issues or disagreements

    The interface register should be reviewed regularly and updated as the project progresses. Overdue and unresolved interfaces should be reported to project management, not left sitting in the register.

    At one geothermal project in Kenya, the interface register identified the critical connection points between the steam gathering system and the power plant, with each interface assigned an owner and a due date. At one thermal power project in Vietnam, the interface register was used to track the resolution of clashes between the boiler and piping systems, with each clash closed before construction began.

    Interface Responsibility Matrix

    An interface responsibility matrix maps each interface to the party responsible for defining, providing, or resolving it.

    • Interfaces: Listed down one axis.
    • Parties: Listed across the other axis.
    • Roles: Each cell shows the role of that party (defines, provides, installs, verifies, approves).

    The matrix makes gaps (no one responsible) and overlaps (two parties both responsible) visible immediately.

    Interface Agreements

    An interface agreement documents how an interface will be managed.

    • Scope: What is included on each side of the interface.
    • Responsibilities: Who is responsible for what.
    • Technical requirements: What each party must provide.
    • Schedule: When each party must deliver.
    • Documentation: What documents are exchanged.
    • Change process: How changes are managed.
    • Dispute resolution: How disputes are resolved.

    Interface agreements should be signed by both parties and treated as contractual documents.

    Interface Coordination in Design

    Many interface issues originate in design.

    • Discipline coordination: Ensuring that disciplines coordinate their designs.
    • 3D modeling and clash detection: Detecting physical clashes before construction.
    • Design reviews: Reviewing designs at discipline interfaces.
    • Interface control documents: Documenting design interfaces.
    • Vendor data integration: Ensuring vendor data is integrated into the design.
    • Design freeze points: Agreeing when interface data (nozzle locations, loads, cable entries) becomes fixed, and controlling changes after that point.
    • Safety reviews: Including interfaces in HAZOP and other safety studies, since hazards often arise at boundaries between systems.

    Design interface coordination prevents problems before they reach the field.

    For thermal power projects in Vietnam (Thai Binh 1, 2×300 MW) and Bangladesh (Bibiyana-III, 400 MW CCGT), design interface coordination included 3D modeling and clash detection between the boiler, turbine, piping, and electrical systems, with clashes resolved before construction began.

    Interface Coordination in Procurement

    Interfaces between equipment vendors and the rest of the plant are often overlooked.

    • Vendor data requirements: Defining what data vendors must provide.
    • Interface schedules: Ensuring vendor data is delivered in time for design.
    • Connection details: Confirming how vendor equipment connects to the plant.
    • Utility requirements: Confirming power, water, air, and other utilities.
    • Control interfaces: Confirming control signals and protocols.
    • Documentation: Ensuring vendor documentation is complete.
    • Vendor-to-vendor interfaces: Confirming how equipment from different suppliers connects (for example, a turbine and its generator, or a package unit and the main control system).

    Vendor interfaces should be defined in the purchase order and managed through the project.

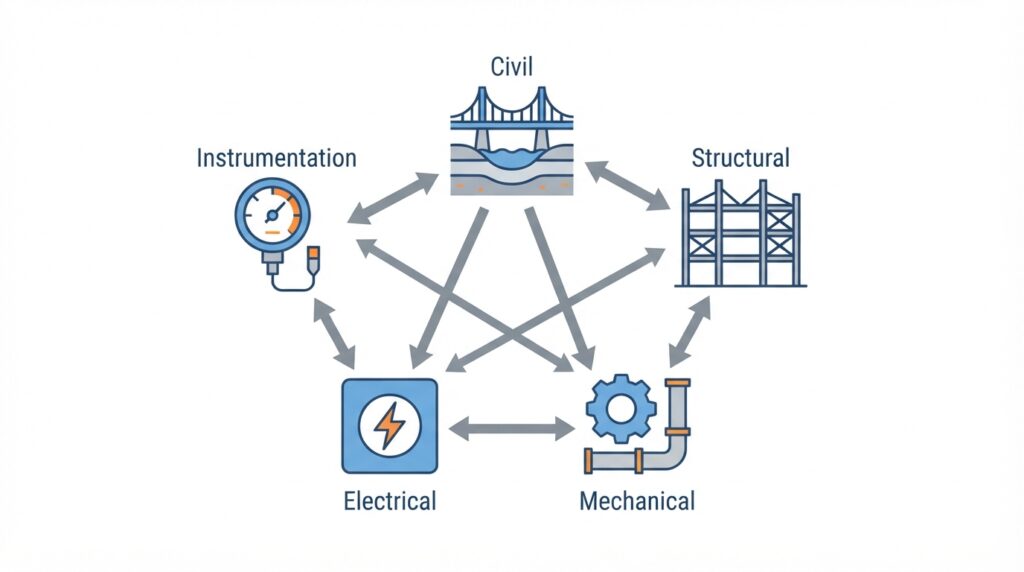

    Interface Coordination in Construction

    Construction is where interface problems become visible.

    • Interface register: Maintaining the register as construction progresses.
    • Coordination meetings: Regular meetings between contractors.
    • Area-based planning: Planning work by area to manage interfaces.
    • Handover procedures: Defining how areas are handed over between contractors.
    • Tie-in planning: Planning connections to existing or live systems, including shutdown windows, isolation, and permits.
    • Inspection: Inspecting interfaces as work is completed.
    • Punch lists: Addressing interface issues before handover.

    Construction interface coordination prevents clashes, rework, and disputes.

    For desalination projects in the Gulf (Taweelah, 909,200 m³/day; Jubail 3A, 600,000 m³/day), construction interface coordination included the interface between the marine works contractor, the process plant contractor, and the electrical and instrumentation contractor, with careful planning of tie-ins and handovers.

    Interface Coordination in Commissioning

    Commissioning involves interfaces between construction and operations.

    • System handover: Defining how systems are handed over from construction to commissioning.
    • Commissioning procedures: Defining how systems are commissioned.
    • Interface testing: Testing interfaces between systems, including control and signal checks.
    • Operations involvement: Involving operations in commissioning.
    • Documentation: Documenting commissioning and handover.

    Commissioning interfaces should be planned well before commissioning begins.

    Resolving Interface Issues

    Identifying interfaces is only half the job. Issues must also be resolved quickly.

    • Raise: Any party can raise an interface issue, recorded in the register.
    • Assign: The issue is assigned an owner and a target date.
    • Resolve: The parties agree a solution and update drawings, specifications, or agreements as needed.
    • Escalate: Issues that cannot be resolved between the parties go to a defined escalation path (for example, discipline lead, then project manager, then project director).
    • Close: The issue is closed only when the resolution has been implemented and verified.

    Unresolved interface issues should be visible in progress reports so they receive management attention before they affect the schedule.

    Interface Changes

    Changes in one area often affect another. A modified equipment size can change foundation loads, pipe routing, and cable lengths. Change control should therefore:

    • Identify which interfaces a proposed change affects.
    • Notify all parties on the other side of those interfaces.
    • Update the interface register, agreements, and drawings.
    • Assess the cost and schedule impact across all affected parties.

    A change approved in one discipline without checking its interfaces simply moves the problem somewhere else.

    Tools and Metrics

    Useful tools:

    • Interface register and responsibility matrix (a spreadsheet is often enough on smaller projects).
    • 3D model and clash detection software.
    • A common data environment where drawings and interface documents are shared and controlled.

    Useful metrics:

    • Number of interfaces open, agreed, and closed.
    • Number of overdue interface actions.
    • Number of clashes detected in design versus in the field.
    • Time taken to close interface issues.

    A rising number of field-detected clashes is a warning that design coordination needs attention.

    Interface Coordination in Small Plants

    Challenges: fewer resources, less expertise, less access to tools, and competing priorities.

    Practical approaches:

    • Focus on critical interfaces: Prioritize coordination of critical interfaces.
    • Use simple tools: Simple interface registers and matrices can be sufficient.
    • Use existing meetings: Leverage existing coordination meetings.
    • Document everything: Good records support coordination and disputes.
    • Train staff: Ensure staff understand interface coordination requirements.
    • Learn from others: Apply lessons from other projects.

    Interface coordination does not need to be complex. It needs to be thorough and consistent.

    Common Mistakes in Interface Coordination

    • No interface coordination process: Interfaces not identified or managed.
    • Incomplete interface identification: Missing interfaces.
    • No interface register: Interfaces not documented.
    • No interface agreements: Responsibilities not defined.
    • Poor discipline coordination: Disciplines work in isolation.
    • Skipping clash detection: Physical clashes found in the field.
    • Ignoring vendor interfaces: Vendor connections not defined.
    • Poor contractor coordination: Contractors do not communicate.
    • Ignoring interface impacts of changes: Changes approved without checking affected interfaces.
    • No escalation path: Issues linger because no one has authority to decide.

    These mistakes are costly to correct. They are much cheaper to avoid through disciplined interface coordination.

    How EPC Partners Inc. Approaches Interface Coordination

    At EPC Partners Inc., we bring practical experience from projects across Asia, the Middle East, Africa, and Europe to interface coordination.

    • Thorough identification: Interfaces are identified systematically, with input from all disciplines.
    • Detailed documentation: Interface registers and agreements are complete and accurate.
    • Disciplined coordination: Regular meetings and coordination between disciplines and contractors.
    • 3D modeling: Extensive use of 3D modeling and clash detection.
    • Clear responsibilities: Scope and responsibilities are clearly defined.
    • Early resolution: Interface issues are resolved early, before they affect construction.
    • Continuous improvement: Lessons are captured and applied.

    Our experience includes supporting geothermal projects in Kenya, Ethiopia, Indonesia, Iceland, and Japan; desalination projects in the UAE, Saudi Arabia, Oman, and Qatar; thermal power projects in Vietnam, Bangladesh, and Japan; and water treatment projects in Vietnam, Kuwait, and Qatar.

    We have also supported clients including Marubeni Corporation, Fuji Electric Co., Ltd., and Toyota Tsusho Corporation on interface coordination aspects of their projects.

    How to Evaluate Interface Coordination Readiness

    Question Why It Matters
    Is there an interface coordination process? Provides a structured approach
    Are interfaces identified comprehensively? Missing interfaces cause problems
    Is there an interface register? Documents and tracks interfaces
    Are interface agreements in place? Defines responsibilities
    Are disciplines coordinated? Prevents design clashes
    Is 3D modeling and clash detection used? Catches physical clashes before construction
    Are vendor interfaces defined? Prevents connection problems
    Are contractors coordinated? Prevents construction conflicts
    Is there an escalation path for unresolved issues? Keeps issues from stalling the project
    Are interface impacts checked in change control? Prevents changes from creating new problems

    A project that addresses these questions is ready for effective interface coordination.

    Key Takeaways

    • Most project problems arise in the gaps between disciplines, contractors, and systems, not within them.
    • Identify interfaces early and comprehensively, and keep identifying them as the project develops.
    • Use an interface register, a responsibility matrix, and signed interface agreements to make ownership clear.
    • Detect clashes in the 3D model, not in the field.
    • Define vendor interfaces in purchase orders.
    • Give every interface issue an owner, a due date, and an escalation path.
    • Check interface impacts whenever changes are proposed.

    Conclusion

    Interface coordination is critical to plant success. For small to medium-scale industrial plants, it determines whether the project runs smoothly or gets bogged down in clashes, rework, and disputes.

    By focusing on interface identification, registers, agreements, discipline coordination, 3D modeling, vendor interfaces, contractor coordination, and commissioning interfaces, owners and project teams can ensure that interfaces are managed proactively rather than discovered in the field.

    If you are planning a plant project and need support with interface coordination or EPC project delivery, contact us to discuss how we can help.

    EPC Partners Inc. is a Japanese EPC support firm with experience supporting power, water, and industrial plant projects across Asia, the Middle East, Africa, and Europe. For more information, visit our project list.

  • Plant Engineering Change Management: Key Practices for EPC Projects

    Plant Engineering Change Management: Key Practices for EPC Projects

    Change is inevitable in EPC projects. Designs evolve, site conditions differ from expectations, vendors propose alternatives, and clients request modifications. Engineering change management is the discipline of controlling these changes—ensuring that they are properly evaluated, approved, documented, and implemented—so that the project stays on track and within budget.

    At EPC Partners Inc., engineering change management has been a core part of our work across a wide range of plant projects—from geothermal power plants in Kenya, Indonesia, and Iceland to large-scale desalination facilities in the UAE and Saudi Arabia, and from thermal power plants in Vietnam and Bangladesh to water treatment plants in Vietnam and Kuwait. Our change management work has ranged from geothermal projects in Kenya and Indonesia, where actual resource conditions required design changes, to thermal power projects in Vietnam and Bangladesh, where vendor-proposed changes were evaluated for performance and cost impact. Each project has presented different challenges, and each has reinforced the same lesson: change is not the enemy. Uncontrolled change is.

    This article covers the key practices in plant engineering change management, drawing on our experience supporting projects across Asia, the Middle East, Africa, and Europe.

    What Is Engineering Change Management?

    Engineering change management is the discipline of controlling changes to engineering deliverables, designs, and specifications after they have been baselined or issued.

    It includes:

    • Change identification: Recognizing when a change is required.
    • Change assessment: Evaluating the impact on scope, cost, schedule, quality, and risk.
    • Change approval: Approving or rejecting the change.
    • Change implementation: Implementing the approved change in all affected deliverables.
    • Change documentation: Recording the change and its impact.
    • Change communication: Communicating the change to affected parties.
    • Change verification and closure: Confirming the change has been implemented and closing it out.

    Why Engineering Change Management Matters

    Factor Impact of Good Change Management Impact of Poor Change Management
    Cost Changes controlled; costs managed Cost overruns from uncontrolled changes
    Schedule Changes evaluated for schedule impact Delays from unplanned changes
    Quality Changes reviewed for quality impact Quality problems from poorly implemented changes
    Safety Changes reviewed for safety and regulatory impact Hazards introduced without review
    Scope Scope changes controlled Scope creep
    Documentation Changes documented Outdated documentation
    Disputes Changes formally approved Disputes over changes

    For small to medium-scale industrial plants, engineering change management often determines whether the project stays within budget and on schedule.

    The Cost of Change Rises Over Time

    A change during early design may require only a revised drawing. The same change after equipment is ordered may require a vendor change order and rework. After construction, it may mean demolition and reinstallation, and after commissioning, shutdown and re-testing. Changes should therefore be identified early, and late changes deserve the most careful assessment.

    Types of Engineering Changes

    Types of engineering changes for EPC projects

    Change Type Description Typical Control Level
    Minor change Small change with minimal impact Simple review and approval
    Major change Significant cost or schedule impact Full change management process
    Emergency change Needed to address an immediate safety or operational issue Fast-track approval with follow-up documentation
    Client-requested change Requested by the owner Formal change order process
    Vendor-proposed change Alternative proposed to improve performance or reduce cost Technical and commercial evaluation before approval
    Design error correction Correction of a design error Design review and approval

    At our geothermal projects in Kenya (Olkaria I Unit 6, 83 MW) and Indonesia (Muara Laboh, 85.2 MW), change management focused on design changes required by the actual geothermal resource conditions—steam quality, pressure, and non-condensable gas content—which differed from the initial assumptions. In Iceland (Theistareykir, 2×45 MW), change management considered the seismic and environmental conditions of the site.

    Change Baselines and Configuration Control

    A change can only be controlled if there is something to change from.

    • Design basis and scope baseline: The agreed design basis, process requirements, and scope of work.
    • Document baseline: Issued-for-design, issued-for-procurement, and issued-for-construction revisions of drawings, specifications, and datasheets.
    • Cost and schedule baselines: The approved budget and schedule against which change impact is measured.

    Changes to a baselined item should always go through the change process, and each document’s revision history should show which approved change it reflects. Design freeze points—for example, before issuing key equipment for purchase or starting construction of an area—concentrate change activity early, when it is least costly.

    Change Identification

    Sources of change:

    • Design and safety reviews: Including HAZOP and constructability reviews.
    • Site conditions: Conditions that differ from expectations.
    • Vendor proposals and vendor data: Alternatives, or final vendor data that differs from design assumptions.
    • Client requests.
    • Construction issues.
    • Commissioning issues.
    • Regulatory or permit changes.

    Identification should be systematic and timely. Every change should be raised through a formal change request so that nothing is implemented informally.

    Change Assessment

    Assessment activities:

    • Technical impact: Effect on design and performance.
    • Cost impact: Engineering, procurement, construction, and commissioning effects.
    • Schedule impact: Including long-lead items and the critical path.
    • Quality impact.
    • Safety and regulatory impact: Effect on safety studies, permits, and compliance.
    • Risk impact.
    • Interface impact: Effect on other disciplines or systems.
    • Operability and maintainability impact.

    Assessment should be thorough and documented.

    For thermal power projects in Vietnam (Thai Binh 1, 2×300 MW) and Bangladesh (Bibiyana-III, 400 MW CCGT), change assessment included the evaluation of design changes proposed by vendors to improve performance or reduce cost, with careful analysis of the impact on plant performance, schedule, and interfaces.

    Project Examples

    At one geothermal project in Indonesia, the actual steam conditions required a change to the turbine design before manufacturing began, with the change assessed for impact on performance, cost, and schedule. At one thermal power project in Vietnam, a vendor-proposed change to the boiler design was assessed for its impact on efficiency and emissions before approval.

    In both cases, the decision was made on documented evidence of impact rather than assumption.

    Change Approval

    Change Type Approval Authority
    Minor change Discipline lead or project engineer
    Major change Project manager and client representative
    Emergency change Designated authority, with follow-up documentation
    Client-requested change Client representative and project manager

    Approval should be documented with the approver’s name, date, and any conditions. Approval limits should be defined at project start so everyone knows who can approve what.

    Change Implementation

    • Design update: Drawings, specifications, and datasheets.
    • Procurement update: Purchase orders and vendor documents, including vendor change orders.
    • Construction update: Construction plans and work packages, and treatment of work already completed.
    • Documentation update: All affected documents, including P&IDs, 3D models, and as-built records.
    • Communication: Informing affected parties.

    An approved change that is only partially reflected in the documents is one of the most common sources of site problems.

    Change Documentation

    Contents:

    • Change description: What is changing and why?
    • Change assessment: Impact on scope, cost, schedule, and quality.
    • Change approval: Who approved it and when.
    • Change implementation: How it was implemented.
    • Affected documents: Which were updated, and to which revision.
    • Communication: Who was informed.

    This provides an audit trail and supports claims, handover, and lessons learned.

    The Change Register

    A central change register should track every change from raising to closure. Typical fields: change number and title, originator and date, type and priority, estimated cost and schedule impact, status (raised, under assessment, approved, rejected, implemented, closed), approver and date, and affected documents and purchase orders.

    Change Communication

    • Notification of affected parties.
    • Distribution of updated documents through document control.
    • Training where required.
    • Follow-up to ensure the change is understood and implemented.

    Communication should be timely and clear, and should reach site teams and vendors as well as the design office.

    Contractual Aspects of Change

    Engineering changes often have contractual consequences. A change that alters scope, price, or schedule typically needs to be handled under the contract’s variation or change order provisions.

    • Know the notice requirements: Contracts often require notice within a defined period; missing it can weaken a party’s position.
    • Separate technical approval from commercial agreement: A change may be approved technically while its cost and time effects are still being negotiated. Track both.
    • Record the basis of the change: Client instruction, differing site conditions, or contractor preference affects who bears the cost.
    • Keep records contemporaneous: Records made at the time are far more useful than reconstruction later.

    Change Control Board

    Responsibilities:

    • Review change requests and assessments.
    • Approve or reject changes.
    • Prioritize by impact and urgency.
    • Monitor implementation of approved changes.

    The CCB should include representatives from engineering, procurement, construction, and the client. It should meet regularly, with a faster route for urgent changes.

    Monitoring Change Performance

    • Number of changes raised, approved, rejected, and open
    • Average time to assess and approve a change
    • Cumulative cost and schedule impact of approved changes
    • Proportion of changes raised after design freeze or after equipment is ordered
    • Number of changes implemented without prior approval (ideally zero)

    A rising number of late changes is an early warning that earlier phases, such as basic design or requirements definition, need attention.

    Engineering Change Management in Small Plants

    Challenges: fewer resources, less expertise, less access to change management systems, and competing priorities.

    Practical approaches:

    • Focus on major changes.
    • Use simple tools: Simple registers and forms can be sufficient.
    • Use clear procedures.
    • Document everything.
    • Train staff.
    • Learn from others: Apply lessons from other projects.

    Change management does not need to be complex. It needs to be thorough and consistent.

    Common Mistakes in Engineering Change Management

    • No change management process: Changes made without formal process.
    • Inadequate change assessment.
    • Poor change documentation.
    • No change communication.
    • Uncontrolled changes: Including informal site changes.
    • Scope creep.
    • Outdated documentation.
    • Ignoring interface effects: A change in one discipline not checked against others.
    • No follow-up: Changes not verified as implemented.

    These mistakes are costly to correct and much cheaper to avoid through disciplined change management.

    How EPC Partners Inc. Approaches Engineering Change Management

    At EPC Partners Inc., we bring practical experience from projects across Asia, the Middle East, Africa, and Europe. As a Japanese EPC support firm, we place particular emphasis on careful assessment before decisions are made, clear documentation, and consistent follow-through.

    Our approach includes:

    • Formal process
    • Thorough assessment of technical, cost, schedule, and quality impact
    • Clear approval by authorized personnel
    • Documentation and tracking
    • Communication to affected parties
    • Follow-up to verify implementation
    • Continuous improvement: Lessons are captured and applied.

    Our experience includes supporting geothermal projects in Kenya, Ethiopia, Indonesia, Iceland, and Japan; desalination projects in the UAE, Saudi Arabia, Oman, and Qatar; thermal power projects in Vietnam, Bangladesh, and Japan; and water treatment projects in Vietnam, Kuwait, and Qatar.

    We have also supported clients including Marubeni Corporation, Fuji Electric Co., Ltd., and Toyota Tsusho Corporation on engineering change management aspects of their projects.

    How to Evaluate Engineering Change Management Readiness

    Question Why It Matters
    Is there a formal change management process? Ensures changes are controlled
    Are baselines and design freeze points defined? Gives a reference for measuring change
    Are changes assessed for impact? Ensures impact is understood
    Are changes approved by authorized personnel? Ensures accountability
    Are changes documented in a change register? Provides an audit trail
    Are affected parties informed? Ensures changes are understood
    Are contractual notice requirements tracked? Protects commercial position
    Are documents updated? Ensures everyone works from current information
    Are changes verified as implemented? Ensures changes are effective

    A project that addresses these questions is ready for effective engineering change management.

    Key Takeaways

    • Change is inevitable; uncontrolled change is what damages projects.
    • Define baselines and design freeze points so change has a reference.
    • Assess every change for technical, cost, schedule, quality, safety, and interface impact.
    • Match the level of approval to the type and impact of the change.
    • Keep a change register, update all affected documents, and verify implementation.
    • Treat the contractual side of change as seriously as the technical side.

    Conclusion

    Engineering change management is critical to plant success. For small to medium-scale industrial plants, it often determines whether the project stays within budget and on schedule.

    By focusing on change identification, assessment, approval, implementation, documentation, and communication, owners and project teams can ensure that changes are controlled and that their impact is understood and managed.

    If you are planning a plant project and need support with engineering change management or EPC project delivery, contact us to discuss how we can help.

    EPC Partners Inc. is a Japanese EPC support firm with experience supporting power, water, and industrial plant projects across Asia, the Middle East, Africa, and Europe. For more information, visit our project list.

  • Plant Documentation and Records Management: Key Practices for EPC Projects

    Plant Documentation and Records Management: Key Practices for EPC Projects

    Every industrial plant project generates vast amounts of documentation: design drawings, specifications, datasheets, calculations, test records, inspection reports, operating procedures, and maintenance manuals. All of it must be created, reviewed, issued, filed, and retained. Documentation and records management is the discipline of ensuring that this information is accurate, accessible, and available to the people who need it, when they need it.

    At EPC Partners Inc., documentation and records management have been a core part of our work across geothermal power plants in Kenya, Indonesia, and Iceland, desalination facilities in the UAE and Saudi Arabia, thermal power plants in Vietnam and Bangladesh, and water treatment plants in Vietnam and Kuwait. Our documentation work has ranged from document control for geothermal projects in Kenya and Indonesia, where P&ID version control was critical, to transmittal management for thermal power projects in Vietnam and Bangladesh, where formal issue of drawings to contractors was essential. Each project has presented different challenges, and each has reinforced the same lesson: documentation is not just paperwork. It is the memory of the project, the record of what was designed, what was built, and what was tested.

    This article covers the key practices in plant documentation and records management, drawing on our experience across Asia, the Middle East, Africa, and Europe.

    What Is Documentation and Records Management?

    It is the discipline of creating, controlling, storing, retrieving, retaining, and archiving project documentation. It includes:

    • Document creation: Producing drawings, specifications, and reports.
    • Document control: Managing versions, approvals, and distribution.
    • Storage and retrieval: Keeping documents in a structured, searchable system.
    • Retention: Keeping documents for the required period.
    • Archiving and disposal: Preserving documents at project closeout and disposing of them when retention periods expire.

    A useful distinction: documents (drawings, procedures, specifications) are controlled and revised as the project develops, while records (test results, inspection reports, signed certificates) provide evidence of what was done and must not be altered. Both need management, but in different ways.

    Why It Matters

    Factor Good Documentation Poor Documentation
    Construction Work proceeds smoothly Rework and delays from missing or outdated information
    Quality Quality verified and documented Quality problems and disputes
    Operations Plant operated and maintained effectively Operational problems
    Compliance Regulatory requirements met Non-compliance and fines
    Disputes Records support claims and defences Disputes lost for lack of evidence
    Handover Smooth handover to operations Difficult handover and operational problems

    For small to medium-scale industrial plants, documentation and records management often determine whether the plant is built correctly and operated effectively.

    Roles and Responsibilities

    Documentation fails most often when nobody owns it. Define clearly:

    • Document controller: Maintains the register, numbering, transmittals, and distribution.
    • Discipline leads: Responsible for the content and technical accuracy of their documents.
    • Project manager: Ensures resources, procedures, and compliance.
    • Owner’s representative: Reviews and approves documents as required by the contract.
    • Vendors and subcontractors: Responsible for supplying documents to the agreed schedule and format.

    In small projects one person may hold several roles, but the responsibilities should still be written down.

    Document Control

    Document control manages document versions, approvals, and distribution. Key activities:

    • Document numbering: A unique number for each document.
    • Version control: Clear revision identification and history.
    • Approval: Review and approval before issue.
    • Distribution: Delivery to the right people.
    • Transmittals: A record of issue and receipt.
    • Superseded documents: Marking old versions as obsolete and removing them from use.

    Document control ensures everyone works from the current, approved version.

    Numbering and metadata. Agree a numbering convention at project start (project, discipline, document type, sequence, revision), and define the metadata each document carries, such as title, status, originator, date, and purpose of issue. Consistent numbering makes search, cross-referencing, and later handover far easier.

    At our geothermal projects in Kenya (Olkaria I Unit 6, 83 MW) and Indonesia (Muara Laboh, 85.2 MW), document control covered P&IDs, equipment datasheets, and test records, with version control ensuring that construction used the latest approved drawings. In Iceland (Theistareykir, 2×45 MW), document control also had to accommodate the documentation practices and regulatory expectations of the local project environment.

    Document Management Systems

    Document management system features for EPC projects

    A document management system (DMS) provides a structured way to store and retrieve documents.

    Feature Description
    Central repository All documents in one place
    Search Fast search by number, title, or content
    Version control Automatic tracking of versions
    Access control Permissions by user or role
    Workflow Review and approval workflows
    Audit trail Record of who accessed or changed documents

    Whatever the tool, the principle is the same: one source of truth, with clear access rights.

    Document Types and Retention

    Document Type Examples Typical Retention
    Design documents P&IDs, PFDs, isometrics, electrical drawings Life of plant
    Equipment documents Datasheets, vendor manuals, spare parts lists Life of plant
    Test records Commissioning records, test certificates Life of plant
    Quality records Inspection reports, material certificates Life of plant
    Operating procedures Startup, operation, shutdown procedures Life of plant
    Maintenance procedures Inspection, maintenance, repair procedures Life of plant
    Safety procedures Emergency procedures, safety data sheets Life of plant
    Regulatory documents Permits, licenses, compliance reports As required by regulation

    Retention requirements vary by document type, contract, and jurisdiction, so always confirm them against local regulations and the contract.

    Review and Approval

    Review and approval ensure documents are correct before use:

    • Internal review: By the originating discipline and other affected disciplines.
    • Client review: By the owner or their representative.
    • Comment resolution: Tracked comments with documented responses.
    • Approval: Formal sign-off by authorized personnel.
    • Issue: Release of the approved document, with a clear status such as “For Review,” “For Approval,” or “For Construction.”

    Status codes matter: a drawing issued “for review” must never be mistaken for one issued “for construction.”

    Transmittals

    Transmittals are the formal record of document issue. A transmittal should include:

    • Transmittal number: A unique identifier.
    • Date: Date of issue.
    • Recipient: Who receives the documents.
    • Documents: What is included, with revision numbers.
    • Purpose: For review, approval, construction, or information.
    • Response required: What response is needed and by when.

    Transmittals provide an audit trail of issue and receipt.

    At one thermal power project in Vietnam, transmittals were used to formally issue the P&IDs and equipment datasheets to the construction contractor, with each transmittal recording the purpose and the required response date. At one geothermal project in Kenya, the transmittal log was used to track the issue of revised drawings as the design developed, ensuring that construction always worked from the latest approved version. On thermal power projects in Vietnam (Thai Binh 1, 2×300 MW) and Bangladesh (Bibiyana-III, 400 MW CCGT), formal transmittals gave clear records of what was issued, when, and to whom.

    Vendor Documentation

    Equipment vendors supply a large share of project documents: datasheets, certified drawings, test certificates, manuals, and spare parts lists. Manage this deliberately:

    • Include a vendor document requirements list (VDRL) in each purchase order, with required formats and due dates.
    • Track vendor submissions in the same register as other project documents.
    • Link payment milestones to delivery of required documents where the contract allows.
    • Check that vendor documents match what was actually supplied, including serial numbers and final test results.

    Late or missing vendor documents are a common cause of delayed handover.

    Managing Changes to Documents

    Design changes during construction and commissioning must be reflected in the documents. Link document control to the project’s change management process: every approved change should identify the documents affected, and those documents should be revised, reissued, and redistributed. For operating plants, the same principle applies under management of change (MOC).

    As-Built Documentation

    As-built documentation reflects the plant as actually built, not as designed:

    • Field verification: Confirming as-built conditions against the design.
    • Marking changes: Recording deviations on drawings during construction.
    • Updating drawings: Revising documents to reflect actual construction.
    • Approval: Reviewing and approving as-built documents.
    • Delivery: Handing them to the owner.

    Collecting as-built markups progressively during construction is far easier than reconstructing them at the end. As-built documents are essential for future maintenance, modifications, and safety.

    Electronic Records, Security, and Backup

    Most project records are now electronic, which brings its own requirements:

    • Use agreed file formats, and keep native files where editing may be needed later.
    • Back up regularly and test restoration.
    • Control access, particularly for commercially sensitive or security-related documents.
    • Plan for long-term readability: file formats and software change over the life of a plant.

    Records Retention and Archiving

    Retention considerations:

    • Regulatory requirements: Retention periods set by law.
    • Contractual requirements: Periods set by the contract, including warranty and defects liability periods.
    • Operational needs: How long documents are needed for operation and maintenance.
    • Legal needs: How long they may be needed for claims or disputes.

    Document these in a retention schedule, and align it with recognized frameworks such as ISO 15489 (records management) and, where applicable, the documented-information requirements of ISO 9001.

    Archiving activities:

    • Selection: Choosing documents to archive.
    • Indexing: Indexing them for retrieval.
    • Storage: Keeping them in a secure, accessible location.
    • Retrieval: Providing access when needed.
    • Disposal: Disposing of documents, securely and with authorization, when retention periods expire.

    Handover Documentation

    At handover, the owner should receive a complete, organized dossier, typically including as-built drawings, final equipment documentation and manuals, test and commissioning records, quality records, certificates, permits, spare parts lists, and operating and maintenance procedures. Agree the content and format of this dossier early, ideally in the contract, so that documents are collected throughout the project rather than assembled in a rush at the end.

    Documentation in Small Plants

    Small plants face particular challenges: fewer resources, less expertise, limited access to document management systems, and competing priorities. Practical approaches:

    • Focus on critical documents: Prioritize those that affect safety, operation, and compliance.
    • Use simple tools: Registers and well-organized shared drives can be sufficient if used consistently.
    • Use templates: Standard templates save time and improve consistency.
    • Document everything important: Good records support operations and resolve disputes.
    • Train staff: Make sure people understand the requirements.
    • Learn from others: Apply lessons from previous projects.

    Documentation management does not need to be complex. It needs to be thorough and consistent.

    Common Mistakes

    • No document control: Documents not controlled or versioned.
    • Poor storage: Documents hard to find or access.
    • Incomplete records: Records missing or unsigned.
    • No transmittals: No record of issue and receipt.
    • Unclear status: Drafts mistaken for approved documents.
    • No as-builts: Drawings that no longer match the plant.
    • Late vendor documents: Missing manuals and certificates at handover.
    • No retention schedule: Documents kept too long or disposed of too early.
    • No backup or archive: Records lost through system failure or staff turnover.
    • No training: Staff unaware of requirements.

    These mistakes are costly to correct and much cheaper to avoid.

    How EPC Partners Inc. Approaches Documentation and Records Management

    Our approach includes:

    • Document control: Controlled, versioned documents with clear status.
    • Document management systems: Structured, accessible storage.
    • Transmittals: Formal issue of documents with clear records.
    • Vendor documentation: Requirements defined at purchase order stage and tracked.
    • As-built documentation: Prepared progressively and delivered at handover.
    • Retention and archiving: Defined schedules and secure archives.
    • Continuous improvement: Lessons captured and applied to later projects.

    Our experience includes geothermal projects in Kenya, Ethiopia, Indonesia, Iceland, and Japan; desalination projects in the UAE, Saudi Arabia, Oman, and Qatar; thermal power projects in Vietnam, Bangladesh, and Japan; and water treatment projects in Vietnam, Kuwait, and Qatar. We have supported clients including Marubeni Corporation, Fuji Electric Co., Ltd., and Toyota Tsusho Corporation on documentation and records management aspects of their projects.

    How to Evaluate Readiness

    Question Why It Matters
    Is there a document control system? Ensures documents are current and approved
    Are roles and responsibilities defined? Ensures accountability
    Is there a numbering convention and status system? Prevents confusion between versions and statuses
    Are documents stored in an accessible system? Ensures documents can be found
    Are transmittals used? Provides an audit trail
    Are vendor document requirements defined? Prevents gaps at handover
    Is as-built documentation planned? Supports maintenance and modifications
    Is there a retention schedule? Ensures documents are kept as long as required
    Are backup and archiving in place? Protects against loss
    Are staff trained? Ensures requirements are understood

    Key Takeaways

    • Documentation is the memory of the project: treat it as an engineering deliverable, not an afterthought.
    • Control versions, statuses, and distribution from day one.
    • Use transmittals to create a clear audit trail.
    • Collect vendor documents and as-built information progressively.
    • Define retention, backup, and archiving early.
    • Simple, consistently used tools beat sophisticated systems used badly.

    Conclusion

    Documentation and records management are critical to plant success. For small to medium-scale industrial plants, they help determine whether the plant is built correctly and operated effectively. By focusing on document control, document management systems, review and approval, transmittals, vendor documentation, as-built records, retention, and archiving, owners and project teams can ensure that documentation supports the project throughout its life.

    EPC Partners Inc. is a Japanese EPC support firm with experience supporting power, water, and industrial plant projects across Asia, the Middle East, Africa, and Europe. If you are planning a plant project and need support with documentation and records management or EPC project delivery, contact us to discuss how we can help. For more information, visit our project list.

  • Plant Project Audits and Reviews: Key Practices for EPC Projects

    Plant Project Audits and Reviews: Key Practices for EPC Projects

    Projects do not fail suddenly. They fail gradually, through small errors, missed steps, and unnoticed problems that accumulate until they become serious. Project audits and reviews are the discipline of catching these problems early, before they become crises. They provide an independent check on project performance (safety, quality, schedule, cost, and compliance) and help the project team identify where improvement is needed.

    At EPC Partners Inc., project audits and reviews have been a core part of our work across a wide range of plant projects, from geothermal power plants in Kenya, Indonesia, and Iceland to large-scale desalination facilities in the UAE and Saudi Arabia, and from thermal power plants in Vietnam and Bangladesh to water treatment plants in Vietnam and Kuwait. Our audit work has ranged from quality audits of welding and pressure testing on geothermal projects in Kenya and Indonesia to project reviews at key milestones on thermal power projects in Vietnam and Bangladesh. Each project has presented different challenges, and each has reinforced the same lesson: audits and reviews are not about finding fault. They are about finding opportunities for improvement.

    This article covers the key practices in plant project audits and reviews, drawing on our experience supporting projects across Asia, the Middle East, Africa, and Europe.

    What Are Project Audits and Reviews?

    Project audits are formal, systematic examinations of project activities, processes, and documentation to verify compliance with requirements and identify opportunities for improvement.

    Project reviews are broader assessments of project performance, typically conducted at key milestones, to evaluate progress, identify risks, and recommend corrective actions.

    Together, they provide independent assurance that the project is on track and show where improvement is needed.

    Why Project Audits and Reviews Matter

    Factor Impact of Good Audits and Reviews Impact of Poor Audits and Reviews
    Compliance Requirements met Non-compliance and penalties
    Quality Quality issues identified and corrected Quality problems persist
    Safety Safety issues identified and corrected Safety incidents
    Schedule Delays identified early Delays discovered too late
    Cost Cost issues identified early Cost overruns
    Risk Risks identified and managed Risks materialize

    For small to medium-scale industrial plants, audits and reviews determine whether the project stays on track and avoids costly surprises.

    Types of Audits and Reviews

    Types of audits and reviews for EPC projects

    Type Description When to Use
    Quality audit Examines quality systems and processes During design and construction
    Safety audit Examines safety systems and practices During construction and commissioning
    Environmental audit Examines environmental compliance During construction and operation
    Contract audit Examines contract administration and compliance During and after contract execution
    Supplier and subcontractor audit Examines the quality, safety, and compliance systems of suppliers and subcontractors Before award and during execution
    Project review Assesses overall project performance At key milestones
    Peer review Independent review by external experts At critical decision points

    Each type requires a different approach and different expertise.

    Standards and Frameworks

    Audits are more credible when they are based on recognized standards. Common references include:

    • ISO 19011: guidelines for auditing management systems, covering audit principles, programme management, and auditor competence.
    • ISO 9001, ISO 45001, and ISO 14001: quality, occupational health and safety, and environmental management system requirements, often used as audit criteria.
    • Technical codes and standards: for example, ASME Section IX for welder and welding procedure qualification, and the applicable codes for pressure testing, electrical work, and piping.
    • Contract and owner requirements: the project specifications, quality plans, and owner or lender requirements that define what “compliant” means for the project.

    The audit criteria should be agreed in advance, so that the audit measures the project against requirements that everyone recognizes.

    Audit Planning

    Audit planning defines what will be audited, when, and by whom.

    Audit planning activities:

    • Define audit scope: What will be audited?
    • Define audit criteria: What standards and requirements apply?
    • Define audit schedule: When will the audit occur?
    • Define audit team: Who will conduct the audit?
    • Define audit methodology: How will the audit be conducted?
    • Define reporting: How will audit findings be reported?

    Audit planning should be based on risk and criticality. Activities where failure would be most serious, or most expensive to correct later, deserve the most attention.

    At our geothermal projects in Kenya (Olkaria I Unit 6, 83 MW) and Indonesia (Muara Laboh, 85.2 MW), audit planning focused on quality systems for welding and pressure testing, given the criticality of these activities for plant safety. In Iceland (Theistareykir, 2×45 MW), audit planning considered the specific regulatory and environmental requirements of the Icelandic project.

    Audit Team

    The audit team should have the skills and experience needed to conduct the audit effectively.

    Audit team considerations:

    • Competence: Does the team have the technical knowledge required?
    • Independence: Is the team independent of the activities being audited?
    • Objectivity: Can the team conduct the audit objectively?
    • Training: Has the team been trained in audit techniques?

    Independence matters because auditors who review their own work, or work of their own colleagues, cannot be fully objective.

    Audit Methodology

    Audit methodology defines how the audit will be conducted.

    Audit methodology activities:

    • Document review: Reviewing project documentation.
    • Interviews: Interviewing project personnel.
    • Site inspection: Inspecting the site and work activities.
    • Testing: Testing systems and processes.
    • Sampling: Sampling activities and records for review.

    The methodology should be appropriate to the scope and objectives of the audit.

    The Audit Process

    A typical audit follows a clear sequence:

    1. Notification: The audited party is informed of the scope, criteria, schedule, and team.
    2. Opening meeting: The audit team confirms the scope, approach, and logistics with the project team.
    3. Fieldwork: The team reviews documents, interviews personnel, inspects the site, and gathers evidence.
    4. Closing meeting: Preliminary findings are presented and discussed, so that there are no surprises and factual errors are corrected.
    5. Reporting: The formal audit report is issued.
    6. Follow-up: Corrective actions are tracked and verified.

    Findings should always be based on objective evidence, such as records, observations, and test results, rather than opinion.

    Audit Findings

    Audit findings are the results of the audit.

    Finding Type Description Action Required
    Major non-conformance Serious deviation from requirements Corrective action required before proceeding
    Minor non-conformance Minor deviation from requirements Corrective action required within a defined period
    Observation Opportunity for improvement Consideration for improvement
    Positive practice Good practice identified Recognition and sharing

    Findings should be documented clearly and objectively, with reference to the specific requirement and the evidence.

    Examples from our projects: At one geothermal project in Indonesia, a quality audit identified that some welders’ qualifications had expired, which was corrected before the affected welds were made. At one thermal power project in Vietnam, a project review at the start of commissioning identified a potential delay in the completion of the control system, allowing corrective action to be taken before it affected the startup schedule.

    Root Cause Analysis

    Correcting an individual finding is not enough if the cause remains. For significant findings, the project team should ask why the problem occurred. Was it a gap in procedures, a training issue, unclear responsibilities, or schedule pressure? Corrective actions that address root causes prevent recurrence. Trends across several audits, such as repeated findings in the same area, often point to systemic issues that need management attention.

    Audit Reporting

    Audit reporting communicates audit findings to management.

    Audit report contents:

    • Audit scope: What was audited?
    • Audit criteria: What standards and requirements applied?
    • Audit findings: What was found?
    • Conclusions: What do the findings mean?
    • Recommendations: What actions are recommended?

    Audit reports should be clear, objective, and actionable, and should reach the people who can act on them.

    Project Reviews

    Project reviews are broader assessments of project performance at key milestones.

    Project review activities:

    • Progress review: Assessing progress against schedule.
    • Cost review: Assessing cost performance against budget.
    • Quality review: Assessing quality performance.
    • Safety review: Assessing safety performance.
    • Risk review: Assessing project risks and mitigation.
    • Stakeholder review: Assessing stakeholder engagement.

    Project reviews should be conducted at key milestones and when significant issues arise. Typical milestones include completion of design, completion of procurement, start of construction, start of commissioning, and handover.

    For thermal power projects in Vietnam (Thai Binh 1, 2×300 MW) and Bangladesh (Bibiyana-III, 400 MW CCGT), project reviews were conducted at key milestones, including completion of design, completion of procurement, start of construction, and start of commissioning, with recommendations for improvement at each stage.

    Stage-Gate and Lender Reviews

    Many projects use formal stage-gate reviews, where the project must demonstrate readiness before moving to the next phase, for example from design to procurement, or from construction to commissioning. Projects with external financing may also be subject to reviews by a lender’s technical advisor or independent engineer. Preparing for these reviews, with complete documentation and clear evidence of progress, helps avoid delays in approvals and funding.

    Peer Reviews

    Peer reviews are independent reviews by external experts.

    Peer review activities:

    • Selection of reviewers: Selecting reviewers with relevant expertise.
    • Review scope: Defining what will be reviewed.
    • Review process: Conducting the review.
    • Review findings: Reporting findings and recommendations.

    Peer reviews provide an independent perspective on project performance and can identify issues that the project team may have missed. They are particularly valuable at critical decision points, such as technology selection, design freeze, and commissioning readiness.

    Supplier and Subcontractor Audits

    Much of the quality and safety performance of a plant project depends on suppliers and subcontractors. Audits of their systems, before award and during execution, help confirm that they can meet requirements. Typical areas include quality management systems, welder and inspector qualifications, calibration of equipment, safety practices, and record-keeping. Findings from supplier and subcontractor audits should be followed up in the same way as findings on the main project.

    Follow-Up and Corrective Action

    Follow-up and corrective action ensure that audit findings are addressed.

    Follow-up activities:

    • Action planning: Developing action plans to address findings.
    • Responsibility assignment: Assigning responsibility for actions.
    • Deadline setting: Setting deadlines for completion.
    • Verification: Verifying that actions are completed and effective.
    • Closure: Closing findings when actions are complete.

    Follow-up should be tracked and reported to management. A finding is not closed until the corrective action has been verified as effective, not merely completed.

    Lessons Learned

    Audits and reviews generate valuable information. Capturing lessons learned, both what went wrong and what worked well, allows the organization to improve on future projects. Lessons should be documented, shared with project teams, and reflected in procedures, checklists, and training.

    Audits and Reviews in Small Plants

    Small plants face particular challenges with audits and reviews.

    Challenges:

    • Fewer resources for audits and reviews.
    • Less expertise.
    • Less access to independent reviewers.
    • Competing priorities.

    Practical approaches:

    • Focus on critical areas: Prioritize audits and reviews of critical areas.
    • Use simple tools: Simple checklists and templates can be sufficient.
    • Use external support: Leverage external auditors or reviewers for specialized expertise.
    • Document everything: Good records support audit and review activities.
    • Train staff: Ensure staff understand audit and review requirements.
    • Learn from others: Apply lessons from other projects.

    Audits and reviews do not need to be complex. They need to be thorough and consistent.

    Common Mistakes in Audits and Reviews

    Even experienced organizations make mistakes. Common ones include:

    • No audit plan: Audits conducted without planning.
    • Inadequate audit scope: Audits too narrow or too broad.
    • Poor audit team: Auditors lacking competence or independence.
    • Weak findings: Findings not clearly documented or substantiated.
    • No root cause analysis: Symptoms corrected while causes remain.
    • No follow-up: Findings not addressed.
    • No reporting: Management not informed of findings.
    • No learning: Lessons not captured and applied.
    • Audits seen as fault-finding: Creating a defensive culture.

    These mistakes are costly to correct. They are much cheaper to avoid through disciplined audits and reviews.

    How EPC Partners Inc. Approaches Audits and Reviews

    At EPC Partners Inc., we bring practical experience from projects across Asia, the Middle East, Africa, and Europe to audits and reviews.

    Our approach includes:

    • Thorough planning: Audits and reviews are planned carefully, with clear scope and criteria.
    • Competent teams: Auditors and reviewers are selected for their competence and independence.
    • Objective findings: Findings are documented clearly and objectively.
    • Actionable recommendations: Recommendations are practical and actionable.
    • Follow-up: Findings are tracked and verified.
    • Constructive approach: Audits and reviews are seen as opportunities for improvement.
    • Continuous improvement: Lessons are captured and applied.

    Our experience includes supporting geothermal projects in Kenya, Ethiopia, Indonesia, Iceland, and Japan; desalination projects in the UAE, Saudi Arabia, Oman, and Qatar; thermal power projects in Vietnam, Bangladesh, and Japan; and water treatment projects in Vietnam, Kuwait, and Qatar.

    We have also supported clients including Marubeni Corporation, Fuji Electric Co., Ltd., and Toyota Tsusho Corporation on audit and review aspects of their projects.

    How to Evaluate Audit and Review Readiness

    Question Why It Matters
    Is there an audit plan? Provides a roadmap for audits
    Are audit criteria agreed in advance? Ensures audits measure against recognized requirements
    Are audits conducted by competent, independent teams? Ensures objectivity and credibility
    Are findings documented clearly and based on evidence? Ensures findings are actionable
    Are root causes analyzed? Prevents recurrence
    Are findings followed up and verified? Ensures issues are addressed
    Are suppliers and subcontractors audited? Extends assurance across the supply chain
    Are reviews conducted at key milestones? Provides early warning of problems
    Are recommendations acted upon? Ensures improvement
    Is there a learning culture? Ensures lessons are applied

    A project that addresses these questions is ready for effective audits and reviews.

    Key Takeaways

    • Audits and reviews are about finding opportunities for improvement, not finding fault.
    • Plan audits based on risk and criticality, and agree the criteria in advance.
    • Use competent, independent auditors, and base findings on objective evidence.
    • Address root causes, and verify that corrective actions are effective.
    • Hold project reviews at key milestones, and extend audits to suppliers and subcontractors.
    • Capture lessons learned and apply them to future projects.

    Conclusion

    Project audits and reviews are critical to plant success. For small to medium-scale industrial plants, they determine whether the project stays on track and avoids costly surprises.

    By focusing on audit planning, audit teams, audit methodology, audit findings, audit reporting, project reviews, peer reviews, and follow-up, owners and project teams can ensure that audits and reviews support the project throughout its life.

    If you are planning a plant project and need support with project audits and reviews or EPC project delivery, contact us to discuss how we can help.

    EPC Partners Inc. is a Japanese EPC support firm with experience supporting power, water, and industrial plant projects across Asia, the Middle East, Africa, and Europe. For more information, visit our project list.

  • Plant Performance Monitoring and Optimization: Key Practices for EPC Projects

    Plant Performance Monitoring and Optimization: Key Practices for EPC Projects

    A plant is designed to perform at a certain level: output, efficiency, emissions, availability. But design performance is not guaranteed. Over time, equipment degrades, operating conditions change, and performance drifts. Performance monitoring and optimization is the discipline of measuring actual performance against design, identifying where it has degraded, and taking action to restore or improve it.

    At EPC Partners Inc., performance monitoring and optimization have been a core part of our work across a wide range of plant projects: geothermal power plants in Kenya, Indonesia, and Iceland; large-scale desalination facilities in the UAE and Saudi Arabia; thermal power plants in Vietnam and Bangladesh; and water treatment plants in Vietnam and Kuwait. Our performance monitoring work has ranged from geothermal projects in Kenya and Indonesia, where steam consumption and turbine efficiency were key indicators, to desalination projects in the Gulf, where membrane performance and energy consumption were critical. Each project has presented different performance challenges, and each has reinforced the same lesson: performance monitoring is not just about collecting data. It is about using data to make better decisions.

    This article covers the key practices in plant performance monitoring and optimization, drawing on our experience supporting projects across Asia, the Middle East, Africa, and Europe.

    What Is Performance Monitoring and Optimization?

    Performance monitoring is the process of measuring actual performance against design or expected performance.

    Performance optimization is the process of taking action to restore or improve performance.

    Together, they include:

    • Performance measurement: Measuring key performance indicators.
    • Performance analysis: Comparing actual performance to expected performance.
    • Performance diagnosis: Identifying the causes of performance gaps.
    • Performance improvement: Taking action to close performance gaps.
    • Performance reporting: Reporting performance to management.

    Performance monitoring and optimization ensure that the plant performs at its best.

    Why Performance Monitoring and Optimization Matter

    Performance monitoring and optimization directly affect plant success.

    Factor Impact of Good Monitoring Impact of Poor Monitoring
    Efficiency Performance maintained or improved Performance degrades over time
    Cost Lower operating costs Higher operating costs
    Reliability Problems detected early Failures and downtime
    Compliance Emissions and discharges within limits Non-compliance
    Output Output maintained at design levels Output declines
    Lifetime Equipment life extended Equipment life shortened

    For small to medium-scale industrial plants, performance monitoring and optimization determine whether the plant delivers value over its life.

    Establishing the Performance Baseline

    Performance can only be judged against a reference. Before monitoring begins, define what “expected” means:

    • Design values: Guaranteed and design performance from the contract and heat and mass balance.
    • Commissioning and acceptance test results: The best measured picture of the as-built plant, typically established through performance tests (for power plants, commonly under ASME PTC or equivalent standards).
    • Correction curves: Corrections for ambient temperature, load, fuel or steam quality, and cooling water temperature, so that results are compared on a like-for-like basis.

    Without a corrected baseline, a heat rate that looks worse in summer may be mistaken for degradation, or real degradation may be hidden by cool weather. Handover data from commissioning should feed directly into the monitoring baseline.

    Key Performance Indicators

    Key performance indicators for industrial plant performance monitoring

    Key performance indicators (KPIs) are the metrics used to measure performance.

    Common KPIs:

    KPI Description Typical Unit
    Output Actual output vs. design output MW, m³/day, tonnes/day
    Heat rate Fuel input per unit of output kJ/kWh
    Efficiency Output divided by input %
    Availability Percentage of time available %
    Reliability Frequency of forced outages (e.g., forced outage rate) % or events/year
    Capacity factor Actual output vs. maximum possible %
    Emissions Emissions per unit of output mg/Nm³, kg/MWh
    Water consumption Water used per unit of output m³/MWh
    Maintenance cost Cost per unit of output $/MWh
    Auxiliary power Power consumed by the plant % of gross output

    KPIs should be relevant, measurable, and actionable. Different plant types also need technology-specific indicators:

    • Geothermal: Steam consumption per MW, turbine efficiency, non-condensable gas content, and resource behavior such as well output and scaling indicators.
    • Desalination: Specific energy consumption (kWh/m³), recovery rate, salt rejection, normalized permeate flow, and membrane differential pressure.
    • Thermal power: Heat rate, condenser pressure, boiler or HRSG efficiency, and gas turbine compressor performance.
    • Water treatment: Treated water quality, chemical consumption, filter run times, and energy per cubic meter.

    At our geothermal projects in Kenya (Olkaria I Unit 6, 83 MW) and Indonesia (Muara Laboh, 85.2 MW), KPIs included steam consumption, turbine efficiency, and availability, with regular monitoring to detect performance degradation. In Iceland (Theistareykir, 2×45 MW), KPIs included heat rate and capacity factor, with careful monitoring of the geothermal resource.

    Performance Measurement

    Performance measurement is the process of collecting data on KPIs.

    Performance measurement activities:

    • Data collection: Collecting data from control systems, meters, and logs.
    • Data validation: Validating data for accuracy and completeness.
    • Data storage: Storing data in a structured format.
    • Data analysis: Analyzing data to calculate KPIs.
    • Data reporting: Reporting KPIs to management.

    Performance measurement should be accurate, consistent, and timely.

    Data quality depends on the instruments behind it. Key flow, temperature, pressure, and power meters should be calibrated on a defined schedule, and drifting or failed instruments should be flagged before they distort the KPIs. A small error in a fuel flow meter, for example, translates directly into an error in heat rate. Plant historians and control system data logging make continuous collection practical; the design stage is the best time to confirm that the instruments needed for performance calculations are installed and accessible.

    Performance Analysis

    Performance analysis is the process of comparing actual performance to expected performance.

    Performance analysis activities:

    • Trend analysis: Analyzing performance trends over time.
    • Benchmarking: Comparing performance to benchmarks or similar plants.
    • Variance analysis: Identifying and analyzing variances from expected performance.
    • Root cause analysis: Identifying the causes of performance gaps.

    Performance analysis should be based on reliable data and sound methods.

    For thermal power projects in Vietnam (Thai Binh 1, 2×300 MW) and Bangladesh (Bibiyana-III, 400 MW CCGT), performance analysis included heat rate trend analysis, comparison of actual output to design output, and identification of performance gaps due to fouling, degradation, or operating conditions.

    Examples from Our Projects

    At one thermal power project in Vietnam, performance analysis identified a gradual increase in heat rate due to condenser fouling, which was corrected by cleaning before it affected output.

    At one geothermal project in Kenya, performance analysis identified a decline in turbine efficiency due to scaling, which was addressed by chemical cleaning.

    In both cases, the problem was found through trend analysis of data the plant was already collecting. The value came from looking at the data regularly and acting early.

    Performance Diagnosis

    Performance diagnosis is the process of identifying the causes of performance gaps.

    Common causes of performance gaps:

    • Fouling: Deposits on heat transfer surfaces.
    • Degradation: Wear, corrosion, or erosion of equipment.
    • Operating conditions: Ambient temperature, fuel quality, load profile.
    • Control issues: Poor tuning, incorrect setpoints.
    • Maintenance issues: Missed maintenance, incorrect repairs.
    • Design issues: Undersized equipment, incorrect specifications.
    • Instrumentation issues: Drifting or faulty instruments that make performance look better or worse than it is.

    Performance diagnosis should be systematic and evidence-based. A useful first step is to separate causes outside the operator’s control (such as ambient conditions) from those that can be corrected, and to check instrument accuracy before concluding that equipment has degraded. Root cause analysis methods such as the 5 Whys and fishbone diagrams help structure the investigation.

    Performance Improvement

    Performance improvement is the process of taking action to close performance gaps.

    Performance improvement activities:

    • Corrective maintenance: Repairing or replacing degraded equipment.
    • Cleaning: Cleaning heat exchangers, filters, and other equipment.
    • Control tuning: Optimizing control loops.
    • Operating practices: Adjusting operating practices to improve performance.
    • Equipment upgrades: Upgrading equipment to improve performance.

    Performance improvement should be prioritized based on the magnitude of the gap and the cost of improvement. Comparing the value of recovered performance (fuel saved, output regained, energy reduced) against the cost and downtime of the fix helps focus effort on the actions with the best return. Some actions can be done online, while others need to wait for a planned outage or turnaround, so improvement planning should be linked to the maintenance schedule.

    For desalination projects in the Gulf (Taweelah, 909,200 m³/day; Jubail 3A, 600,000 m³/day), performance improvement included membrane cleaning and replacement, energy recovery device optimization, and pump efficiency improvements, with careful monitoring of water quality and energy consumption.

    After any improvement, performance should be re-measured to confirm that the gap has actually closed and to update the baseline.

    Performance Reporting

    Performance reporting keeps management informed of performance.

    Performance report contents:

    • KPIs: Current values of key performance indicators.
    • Trends: Performance trends over time.
    • Variances: Variances from expected performance.
    • Actions: Actions being taken to improve performance.
    • Forecast: Predicted future performance.

    Reports should be accurate, timely, and clear. Reporting frequency should match the audience: daily or weekly views for operators, monthly reports for plant management, and periodic summaries for owners and lenders.

    Performance Monitoring and Optimization in Small Plants

    Small plants face particular challenges with performance monitoring and optimization.

    Challenges:

    • Fewer resources for monitoring.
    • Less expertise.
    • Less access to performance monitoring tools.
    • Competing priorities.

    Practical approaches:

    • Focus on key KPIs: Prioritize the most important performance indicators.
    • Use simple tools: Simple spreadsheets and logs can be sufficient.
    • Use vendor data: Leverage vendor performance data and curves.
    • Seek expert advice: Get advice from experienced engineers.
    • Document everything: Good records support analysis and improvement.
    • Learn from others: Apply lessons from other projects.

    Performance monitoring does not need to be complex. It needs to be consistent and focused.

    Common Mistakes in Performance Monitoring and Optimization

    Even experienced organizations make mistakes. Common ones include:

    • No performance monitoring: Performance not measured.
    • Poor data quality: Inaccurate or incomplete data, including uncalibrated instruments.
    • No corrected baseline: Actual results compared to design without correcting for operating conditions.
    • No performance analysis: Data collected but not analyzed.
    • No performance diagnosis: Causes of gaps not identified.
    • No performance improvement: Gaps not addressed.
    • No performance reporting: Management not informed.
    • Ignoring trends: Missing early warning signs.
    • No continuous improvement: Performance not improved over time.

    These mistakes are costly to correct. They are much cheaper to avoid through disciplined performance monitoring and optimization.

    How EPC Partners Inc. Approaches Performance Monitoring and Optimization

    At EPC Partners Inc., we bring practical experience from projects across Asia, the Middle East, Africa, and Europe to performance monitoring and optimization.

    Our approach includes:

    • KPI definition: KPIs are defined based on project objectives.
    • Baseline establishment: Design and test data are used to set corrected performance baselines.
    • Data collection: Data is collected accurately and consistently.
    • Performance analysis: Performance is analyzed against expected values.
    • Performance diagnosis: Causes of performance gaps are identified.
    • Performance improvement: Actions are taken to close gaps.
    • Performance reporting: Performance is reported to management.
    • Continuous improvement: Lessons are captured and applied.

    Our experience includes supporting geothermal projects in Kenya, Ethiopia, Indonesia, Iceland, and Japan; desalination projects in the UAE, Saudi Arabia, Oman, and Qatar; thermal power projects in Vietnam, Bangladesh, and Japan; and water treatment projects in Vietnam, Kuwait, and Qatar.

    We have also supported clients including Marubeni Corporation, Fuji Electric Co., Ltd., and Toyota Tsusho Corporation on performance monitoring and optimization aspects of their projects.

    How to Evaluate Performance Monitoring and Optimization Readiness

    When reviewing performance monitoring and optimization, ask:

    Question Why It Matters
    Are KPIs defined? Provides the basis for monitoring
    Is a corrected baseline established? Allows like-for-like comparison
    Is data collected accurately? Ensures analysis is reliable
    Are instruments calibrated? Prevents misleading results
    Is performance analyzed? Identifies performance gaps
    Are causes of gaps diagnosed? Enables targeted improvement
    Is performance improved? Closes performance gaps
    Is performance reported? Keeps management informed
    Is there continuous improvement? Sustains performance over time

    A project that addresses these questions is ready for effective performance monitoring and optimization.

    Key Takeaways

    • Define KPIs and a corrected performance baseline before the plant starts operating.
    • Good decisions depend on good data: validate it and keep instruments calibrated.
    • Trend analysis catches problems like fouling and scaling early, before output is affected.
    • Diagnose before you act, and prioritize improvements by gap size and cost.
    • Re-measure after every improvement and report results to management.
    • Keep it simple and consistent, especially in small plants.

    Conclusion

    Performance monitoring and optimization are critical to plant success. For small to medium-scale industrial plants, they determine whether the plant delivers value over its life.

    By focusing on KPI definition, performance measurement, performance analysis, performance diagnosis, performance improvement, and performance reporting, owners and project teams can ensure that the plant performs at its best.

    If you are planning a plant project and need support with performance monitoring and optimization or EPC project delivery, contact us to discuss how we can help.

    EPC Partners Inc. is a Japanese EPC support firm with experience supporting power, water, and industrial plant projects across Asia, the Middle East, Africa, and Europe. For more information, visit our project list.

  • Plant Commissioning and Startup: Key Practices for EPC Projects

    Plant Commissioning and Startup: Key Practices for EPC Projects

    Commissioning and startup are where everything the project team has designed and built is proven in practice. After months or years of engineering, procurement, and construction, the plant is energized, filled with process fluids, and brought up to operating conditions. Every system is tested, every safety device is verified, and operators learn how the plant actually behaves. A successful commissioning and startup means the plant enters commercial operation smoothly. A poor one means delays, cost overruns, and problems that persist for years.

    At EPC Partners Inc., commissioning and startup have been a core part of our work across a wide range of plant projects: geothermal power plants in Kenya, Indonesia, and Iceland; large-scale desalination facilities in the UAE and Saudi Arabia; thermal power plants in Vietnam and Bangladesh; and water treatment plants in Vietnam and Kuwait. Our commissioning work has ranged from geothermal projects in Kenya and Indonesia, where steam blow and turbine roll were critical milestones, to desalination projects in the Gulf, where membrane system startup and water quality testing were essential. Each project has presented different challenges, and each has reinforced the same lesson: commissioning is not only a technical exercise. It is a planning, organization, and communication exercise as well.

    This article covers the key practices in plant commissioning and startup, drawing on our experience supporting projects across Asia, the Middle East, Africa, and Europe.

    What Is Commissioning and Startup?

    Commissioning is the process of verifying that every system in the plant works as designed. Startup is the process of bringing the plant into operation. Commercial operation follows once performance has been demonstrated and the owner accepts the plant.

    The main phases are:

    • Mechanical completion and turnover: Construction hands completed systems over to the commissioning team.
    • Pre-commissioning: Static checks, cleaning, and preparation before energization or startup.
    • Cold commissioning: Testing without process fluids, or at ambient conditions.
    • Hot commissioning: Testing with process fluids at operating conditions.
    • Integrated testing: Testing interconnected systems together under operating conditions.
    • Performance testing: Verifying that the plant meets its contractual performance guarantees.
    • Startup and trial operation: Bringing the plant into stable, continuous operation and, where required, demonstrating reliability before acceptance.

    Together, these ensure the plant is ready for safe and reliable operation.

    Why Commissioning and Startup Matter

    Factor Impact of Good Commissioning Impact of Poor Commissioning
    Safety Systems verified safe before startup Safety incidents during startup
    Performance Plant meets performance guarantees Plant underperforms
    Reliability Systems function as designed Early failures and downtime
    Schedule Startup on time Delays from commissioning problems
    Cost Rework avoided Rework and extended commissioning
    Handover Smooth transition to operations Difficult handover

    For small to medium-scale industrial plants, commissioning and startup determine whether the plant starts up smoothly and meets its performance targets.

    Commissioning Planning

    Commissioning and startup sequence for industrial plants

    Commissioning planning is the foundation of successful commissioning.

    Key planning activities:

    • Define scope: Which systems will be commissioned?
    • Define sequence: In what order? Utilities and power distribution usually come first, then the systems that depend on them.
    • Define organization: Who is responsible for what?
    • Define schedule: When will each activity occur, and how does it fit with remaining construction?
    • Define resources: What people, tools, temporary equipment, consumables, and utilities are needed?
    • Define procedures: How will each system be commissioned?
    • Define acceptance criteria: What counts as successful commissioning?
    • Define the safety approach: How will permits, isolation, and simultaneous construction and commissioning activities be controlled?

    Commissioning planning should begin during construction, and ideally during engineering, so that the design supports commissioning (test connections, temporary strainers, vents and drains, and access for calibration).

    At our geothermal projects in Kenya (Olkaria I Unit 6, 83 MW) and Indonesia (Muara Laboh, 85.2 MW), commissioning planning covered the sequence for steam blow, turbine roll, and grid synchronization, with careful coordination of drilling, steam gathering, and power plant systems. In Iceland (Theistareykir, 2×45 MW), planning took into account the short construction season and the need to complete commissioning before winter.

    Commissioning Organization

    A clear organization is essential.

    Role Responsibility
    Commissioning Manager Overall responsibility for commissioning
    Commissioning Engineers System-specific commissioning
    Operations Representative Operations input and readiness
    Safety Representative Safety oversight during commissioning
    Vendor Representatives Equipment-specific commissioning support
    Contractor Representatives Construction support and punch list completion

    For small plants, roles may be combined, but every function must still be covered. Reporting lines and decision authority, especially for stopping work on safety grounds, should be clear before commissioning begins.

    Mechanical Completion and System Turnover

    Commissioning is easier when work is handed over system by system, not all at once at the end of construction.

    • Define systems and subsystems early, with clear boundaries, so each can be completed, turned over, and commissioned on its own.
    • Verify mechanical completion: installation checks, torque and alignment records, and inspection sign-offs.
    • Classify the punch list: items that must be closed before commissioning, items that must be closed before startup, and items that can wait until after startup.
    • Agree on formal turnover certificates so responsibility for each system is unambiguous.
    • Control access: once a system is turned over or energized, changes and entry should be managed through permits.

    Pre-Commissioning

    Pre-commissioning is the preparation phase before energization or startup.

    • Static checks: verifying that equipment is installed correctly.
    • Cleaning and flushing: removing debris and contaminants.
    • Pressure testing: testing piping and vessels for strength and leak tightness.
    • Instrument calibration and loop checks: verifying signals from field device to control system.
    • Electrical checks: insulation, protection relay settings, and verification before energization.
    • Safety system checks: verifying that safety systems function correctly.

    Pre-commissioning is often the most time-consuming phase, and rushing it leads to problems later. For our thermal power projects in Vietnam (Thai Binh 1, 2×300 MW) and Bangladesh (Bibiyana-III, 400 MW CCGT), pre-commissioning included thorough cleaning of steam piping to remove construction debris, calibration of instrumentation, and verification of safety interlocks before first fire.

    Cold Commissioning

    Cold commissioning tests systems without process fluids or at ambient conditions.

    • Motor rotation checks: correct direction before coupling.
    • Pump and fan testing: operation without process load.
    • Control loop testing: confirming loops respond correctly.
    • Valve operation: open, close, modulate, and fail-safe position.
    • Interlock and alarm testing: confirming safety interlocks and alarms function.
    • Utilities: power, instrument air, cooling water, and other utilities proven before process systems depend on them.

    Cold commissioning verifies that systems work mechanically and electrically before process fluids are introduced.

    Hot Commissioning

    Hot commissioning tests systems with process fluids at operating conditions.

    • System startup: starting individual systems and verifying operation.
    • Process parameter verification: confirming temperature, pressure, flow, and other parameters meet design values.
    • Control loop tuning: tuning for stable, responsive control.
    • Equipment performance: confirming equipment operates within design parameters, including vibration and temperature monitoring.
    • Emissions and discharge checks: verifying regulatory limits are met.

    Hot commissioning is where many problems surface, and it requires close coordination between contractor, owner, and equipment vendors.

    For desalination projects in the Gulf (Taweelah, 909,200 m³/day; Jubail 3A, 600,000 m³/day), hot commissioning included the startup of high-pressure pumps, membrane systems, and energy recovery devices, with careful attention to water quality and energy consumption.

    Project experience: At one thermal power project in Vietnam, hot commissioning included steam blow and turbine roll, with careful monitoring of steam chemistry and turbine protection systems before synchronization to the grid. At one geothermal project in Kenya, hot commissioning included the startup of the steam turbine and generator, with close coordination between the drilling, steam gathering, and power plant teams.

    Integrated Testing

    Integrated testing verifies that interconnected systems work together.

    • Full plant operation: running the plant as a whole, not only individual systems.
    • Load testing: operating across the load range.
    • Transient testing: response to load changes, trips, and other disturbances.
    • Safety system verification: confirming protective functions work under realistic conditions, using agreed procedures that do not put the plant at unnecessary risk.

    This is where the plant is proven as a complete system, not just a collection of components.

    Performance Testing

    Performance testing verifies that the plant meets its contractual guarantees.

    • Output testing: capacity or production rate (MW, m³/day, throughput).
    • Efficiency testing: heat rate for power plants; specific energy consumption and recovery for desalination and water treatment plants.
    • Product quality: for example, product water quality.
    • Emissions testing: compliance with guaranteed or regulatory limits.
    • Availability and reliability: some contracts require a demonstration run over a defined period.

    Performance testing must follow the procedures specified in the contract, including reference conditions, test methods, instrument accuracy, and measurement uncertainty. Test procedures should be agreed with all parties well before the tests begin.

    Startup and Trial Operation

    Startup is the process of bringing the plant into stable, continuous operation.

    • System readiness: confirming all required systems, permits, and utilities are ready.
    • Operator readiness: confirming operators are trained and procedures are available.
    • Startup sequence: following the planned sequence for each system.
    • Monitoring: tracking performance, vibration, temperatures, and alarms closely.
    • Issue resolution: resolving problems quickly, with a clear process for decisions.
    • Trial operation: where required, running the plant continuously to demonstrate reliability before acceptance.

    Startup should be planned and controlled. A pre-startup safety review, with sign-off from operations, safety, and the commissioning team, helps confirm the plant is ready.

    Commissioning Safety

    Commissioning is one of the highest-risk phases of a project. Systems are being energized and pressurized for the first time, while construction work may still be in progress.

    • Permit-to-work and isolation (lockout/tagout) for all work on commissioned systems.
    • Clear segregation between energized or live systems and ongoing construction areas.
    • Hazard reviews for first-time operations such as steam blow, chemical cleaning, and high-pressure testing.
    • Emergency response arrangements and drills that cover the commissioning period.
    • Authority to stop work for anyone who sees an unsafe condition.

    Commissioning Documentation

    • Commissioning procedures: one for each system.
    • Commissioning records: tests and results.
    • Test certificates: for equipment and systems.
    • Punch lists: outstanding items, classified by priority.
    • As-built drawings: reflecting actual construction and any changes made during commissioning.
    • Operating and maintenance procedures: for the operations team.
    • Lessons learned records: captured as the work progresses.

    Documentation must be complete, accurate, and accessible.

    Handover and Post-Startup Support

    Commissioning does not end when the plant starts up.

    • Formal acceptance based on completed performance tests and agreed acceptance criteria.
    • Closure of remaining punch list items with owners and dates.
    • Transfer of documentation, spare parts, and special tools to the owner.
    • Warranty or defects liability period: a clear process for reporting and resolving defects.
    • Post-startup support: a period where commissioning engineers and vendors remain available to the operations team.

    Commissioning and Startup in Small Plants

    Small plants face particular challenges: fewer resources, less in-house expertise, limited vendor support, and competing priorities.

    Practical approaches:

    • Plan early: begin during engineering or construction.
    • Use vendor support: engage vendors for equipment commissioning.
    • Involve operations: operators should take part in commissioning, not just receive the plant afterwards.
    • Document everything: good records support handover and operations.
    • Focus on critical systems: prioritize safety-critical systems.
    • Apply lessons from other projects: use checklists and procedures from similar plants.

    Commissioning does not need to be complex. It needs to be thorough and well planned.

    Common Mistakes in Commissioning and Startup

    • Insufficient pre-commissioning: leading to problems during hot commissioning.
    • Instrument calibration errors: causing inaccurate readings and poor control.
    • Control loop tuning problems: causing instability.
    • Equipment failures: leading to delays and rework.
    • Safety system issues: requiring redesign or modification.
    • Documentation gaps: making handover difficult.
    • Schedule pressure: leading to rushed testing and missed problems.
    • Unclear turnover: systems commissioned while construction work is still unfinished.
    • No operator involvement: operators unprepared for startup.
    • Poorly agreed performance test procedures: leading to disputes over results.

    These mistakes are costly to correct and much cheaper to avoid through disciplined commissioning.

    How EPC Partners Inc. Approaches Commissioning and Startup

    At EPC Partners Inc., we bring practical experience from projects across Asia, the Middle East, Africa, and Europe.

    • Thorough planning: clear procedures and acceptance criteria.
    • Detailed preparation: pre-commissioning completed before startup.
    • Disciplined execution: a controlled sequence with defined hold points.
    • Comprehensive documentation: complete and accurate records.
    • Operator involvement: operations staff take part throughout.
    • Safety focus: safety is prioritized at every stage.
    • Continuous improvement: lessons are captured and applied to later projects.

    Our experience includes supporting geothermal projects in Kenya, Ethiopia, Indonesia, Iceland, and Japan; desalination projects in the UAE, Saudi Arabia, Oman, and Qatar; thermal power projects in Vietnam, Bangladesh, and Japan; and water treatment projects in Vietnam, Kuwait, and Qatar. We have also supported clients including Marubeni Corporation, Fuji Electric Co., Ltd., and Toyota Tsusho Corporation on commissioning and startup aspects of their projects.

    How to Evaluate Commissioning and Startup Readiness

    Question Why It Matters
    Is there a commissioning plan? Provides a roadmap
    Is the turnover process defined? Prevents overlap between construction and commissioning
    Is pre-commissioning thorough? Prevents problems during hot commissioning
    Are procedures prepared? Defines how systems will be commissioned
    Is the organization in place? Ensures clear responsibilities
    Are operators involved and trained? Builds familiarity and readiness
    Are safety systems and permits in place? Ensures safe operation
    Is documentation complete? Supports handover and operations
    Is performance testing planned and agreed? Verifies contractual guarantees
    Is startup and post-startup support planned? Ensures a smooth transition to operation

    A project that can answer yes to these questions is well prepared for commissioning and startup.

    Conclusion

    Commissioning and startup are the final proof of everything the project team has designed and built. For small to medium-scale industrial plants, they determine whether the plant starts up smoothly, meets its performance guarantees, and is ready for reliable operation.

    By focusing on commissioning planning, organization, turnover, pre-commissioning, cold and hot commissioning, integrated and performance testing, safe startup, and a structured handover, owners and project teams can enter commercial operation with confidence.

    If you are planning a plant project and need support with commissioning and startup or EPC project delivery, contact us to discuss how we can help.

    EPC Partners Inc. is a Japanese EPC support firm with experience supporting power, water, and industrial plant projects across Asia, the Middle East, Africa, and Europe. For more information, visit our project list.

  • Plant Subcontractor Management: Key Practices for EPC Projects

    Plant Subcontractor Management: Key Practices for EPC Projects

    Most EPC projects rely on subcontractors. Civil works, mechanical erection, electrical installation, piping fabrication, insulation, painting, and marine works are often performed by specialist subcontractors rather than the main contractor’s own workforce. Subcontractor management is the discipline of selecting, contracting, coordinating, and supervising these subcontractors so that their work meets the project’s requirements for safety, quality, schedule, and cost.

    At EPC Partners Inc., subcontractor management has been a core part of our work across a wide range of plant projects: geothermal power plants in Kenya, Indonesia, and Iceland; large-scale desalination facilities in the UAE and Saudi Arabia; thermal power plants in Vietnam and Bangladesh; and water treatment plants in Vietnam and Kuwait. Our work has ranged from remote geothermal sites, where capable local subcontractors and careful mobilization were essential, to large-scale desalination projects in the Gulf, where coordination between multiple specialist subcontractors was critical. Each project has presented different challenges, and each has reinforced the same lesson: subcontractors are not just suppliers of labor. They are partners in delivering the project, and their performance largely determines its success.

    This article covers the key practices in plant subcontractor management, drawing on our experience supporting projects across Asia, the Middle East, Africa, and Europe.

    What Is Subcontractor Management?

    Subcontractor management covers the full life of a subcontract, from the decision to subcontract through to closeout. It includes:

    • Subcontractor selection: Identifying, prequalifying, and selecting qualified subcontractors.
    • Subcontractor contracting: Negotiating and awarding subcontracts.
    • Subcontractor mobilization: Ensuring subcontractors are ready to start work.
    • Subcontractor supervision: Monitoring subcontractor performance on site.
    • Subcontractor coordination: Managing interfaces between subcontractors and with the main contractor’s own work.
    • Subcontractor performance management: Evaluating performance and taking action.
    • Subcontractor payment and closeout: Paying correctly, closing out scope, and handing over records.

    Together, these ensure that subcontractors deliver their work safely, on time, and to the required quality.

    Why Subcontractor Management Matters

    Subcontractor management directly affects project success. Because the main contractor remains responsible to the owner for subcontracted work, a subcontractor’s failure becomes the project’s failure.

    Factor Impact of Good Subcontractor Management Impact of Poor Subcontractor Management
    Safety Subcontractors work safely Incidents and injuries
    Quality Work meets specifications Rework and defects
    Schedule Work completed on time Delays and inefficiency
    Cost Costs controlled Cost overruns and claims
    Coordination Subcontractors work together Conflicts and interface problems
    Compliance Legal, labor, and permit requirements met Penalties, stoppages, and liability
    Reputation Positive reputation Reputation damaged

    For small to medium-scale industrial plants, subcontractor management often determines whether construction proceeds smoothly.

    Aligning Subcontracts with the Main Contract

    A subcontract should never be written in isolation. The main contract imposes obligations on the contractor (schedule, performance guarantees, liquidated damages, quality and safety standards, documentation, warranties), and these need to flow down to subcontractors in a way that matches what the subcontractor can actually control.

    Key points:

    • Flow-down of requirements: Technical specifications, HSE rules, quality requirements, and reporting duties should carry through to the subcontract.
    • Back-to-back terms: Delay damages, warranty periods, and change procedures should be aligned so the contractor is not exposed to risks it cannot pass on.
    • Scope boundaries: Define precisely what is included and excluded, who supplies materials, equipment, and temporary works, and who is responsible for each interface.
    • Owner approvals: Confirm whether the owner has approval rights over subcontractors, and obtain approvals early.

    Subcontractor Selection

    Subcontractor selection is the first step in subcontractor management, and the cheapest point at which to prevent problems.

    Selection criteria:

    Criterion Description
    Technical capability Can the subcontractor perform the work?
    Experience Has the subcontractor done similar work, in similar conditions?
    Safety record What is the subcontractor’s safety performance?
    Quality record What is the subcontractor’s quality performance?
    Financial strength Is the subcontractor financially stable enough to complete the work and carry its payroll and materials?
    Capacity Can the subcontractor provide the manpower, supervision, and equipment to meet the schedule?
    Local knowledge Does the subcontractor understand local regulations, labor practices, and logistics?
    References What do previous clients say?

    A sound process includes:

    • Prequalification: Screening candidates before issuing the tender.
    • Clear tender documents: Scope, specifications, schedule, and commercial terms.
    • Bid evaluation: Comparing technical and commercial offers on the same basis, including clarifications and exclusions.
    • Capability checks: Reviewing key personnel, equipment, and, where practical, visiting a current project or the fabrication shop.

    Selection should be based on objective criteria, not preference, and should look beyond the lowest price. An unrealistically low bid is often a warning sign of misunderstood scope.

    At our geothermal projects in Kenya (Olkaria I Unit 6, 83 MW) and Indonesia (Muara Laboh, 85.2 MW), subcontractor selection for civil works and mechanical erection considered experience in remote, difficult terrain and familiarity with geothermal construction. In Iceland (Theistareykir, 2×45 MW), selection considered experience with seismic design and cold-weather construction.

    Subcontractor selection criteria for EPC projects

    Subcontractor Contracting

    Subcontractor contracting is the process of negotiating and awarding subcontracts.

    Subcontract contents:

    • Scope: What work is included, and what is not?
    • Price: What is the price, and how is it structured (lump sum, unit rate, reimbursable)?
    • Schedule: Start, key milestones, and completion dates.
    • Quality: Applicable standards, inspection and test plans, and hold points.
    • Safety and environment: Site rules, permit-to-work requirements, and reporting duties.
    • Insurance and security: Required insurances, performance bonds, advance payment guarantees, and retention.
    • Payment terms: When and how payment is made, and what documents support it.
    • Change process: How variations are requested, priced, approved, and instructed.
    • Delay and default: Remedies, liquidated damages, and notice requirements.
    • Warranty and defects: Warranty period and obligations for correcting defects.
    • Termination: Conditions and consequences, including step-in rights.
    • Records and documentation: Required reports, as-built information, and turnover documents.
    • Compliance: Applicable laws, labor and immigration requirements, and ethics and anti-corruption obligations.

    Subcontracts should be clear and complete to avoid disputes. Where subcontractors are expected to use sub-tier subcontractors, the subcontract should state whether approval is required and that the subcontractor remains responsible for their work.

    Subcontractor Mobilization

    Subcontractor mobilization ensures that subcontractors are ready to start work.

    Mobilization activities:

    • Site induction: Inducting subcontractor personnel on site rules and safety.
    • Training and competency: Confirming that personnel hold required skills, certifications, and medical clearances (for example, welders, riggers, crane operators, and electricians).
    • Permits and access: Securing work permits, visas, site passes, and area access.
    • Equipment: Ensuring that equipment is available, inspected, and suitable.
    • Materials: Ensuring that materials are available, and that laydown areas and storage are allocated.
    • Procedures and plans: Reviewing and approving method statements, safety plans, quality plans, and schedules before work begins.
    • Welfare and logistics: Arranging accommodation, transport, and site facilities where needed, especially at remote sites.

    Mobilization should be planned to avoid delays at the start of work. Releasing a work front before approved procedures, permits, and competent personnel are in place is a common source of early problems.

    Subcontractor Supervision

    Subcontractor supervision monitors subcontractor performance.

    Supervision activities:

    • Daily supervision: Supervising work on a daily basis.
    • Safety supervision: Ensuring work is performed safely, including permit-to-work compliance and toolbox talks.
    • Quality supervision: Ensuring work meets specifications, including witnessing inspections and tests at hold points.
    • Progress monitoring: Tracking progress against schedule using agreed measures.
    • Issue resolution: Resolving problems as they arise, with clear escalation routes.

    Supervision should be proactive: identifying and addressing problems before they escalate. It should also be proportionate, since over-supervision can slow work and blur responsibility, while under-supervision lets small problems grow.

    On thermal power projects in Vietnam (Thai Binh 1, 2×300 MW) and Bangladesh (Bibiyana-III, 400 MW CCGT), subcontractor supervision included daily progress meetings, safety inspections, and quality checks, with clear channels for raising and resolving issues.

    Project Experience: Supervision in Practice

    At one thermal power project in Vietnam, supervision of the mechanical erection and electrical subcontractors relied on daily progress meetings, with safety inspections and quality checks completed before each work front was released. The discipline of checking readiness before release reduced rework and kept the two subcontractors from working in each other’s way.

    At another project in Bangladesh, coordination between the civil, mechanical, and electrical subcontractors required careful sequencing of area handovers, so that each trade received a ready, safe, and accessible work front.

    Subcontractor Coordination

    Subcontractor coordination ensures that subcontractors work together and with the main contractor’s own activities.

    Coordination activities:

    • Interface management: Identifying and managing interfaces between subcontractors.
    • Coordination meetings: Regular meetings to coordinate work, with actions tracked to closure.
    • Area-based planning: Planning work by area to manage interfaces, access, and shared resources such as cranes and laydown.
    • Handover procedures: Defining how areas and systems are handed over between subcontractors.
    • Integrated schedule: Maintaining a master schedule that incorporates subcontractor schedules and reflects their dependencies.

    Coordination is especially important in complex projects with multiple subcontractors.

    For desalination projects in the Gulf (Taweelah, 909,200 m³/day; Jubail 3A, 600,000 m³/day), coordination covered the interfaces between the marine works subcontractor, the process plant subcontractor, and the electrical and instrumentation subcontractor, with careful planning of tie-ins and handovers.

    Subcontractor Performance Management

    Subcontractor performance management evaluates and manages subcontractor performance.

    Performance management activities:

    • Performance metrics: Defining metrics for safety, quality, schedule, and cost (for example, incident rates, non-conformance closure, progress against plan, and variation levels).
    • Performance monitoring: Monitoring performance against metrics.
    • Performance reviews: Regular reviews with the subcontractor’s management.
    • Corrective action: Taking action when performance falls short, from formal notices to recovery plans and, where necessary, additional resources or replacement.
    • Recognition: Recognizing good performance.

    Performance management should be fair, consistent, and based on objective data.

    Managing Changes and Claims

    Changes and claims are among the most common sources of subcontractor disputes.

    • Written instructions: Changes should be instructed in writing before work proceeds.
    • Prompt pricing: Variations should be priced and agreed promptly, using rates set out in the subcontract where possible.
    • Notice discipline: Both sides should respect notice periods for delay, variation, and claim events.
    • Contemporaneous records: Daily reports, photographs, manpower and equipment records, and correspondence support fair assessment.
    • Pass-through: Owner-driven changes and delays should be assessed so that valid entitlements are passed to the owner, and subcontractor entitlements are managed consistently with the main contract.

    Health, Safety, and Environment

    Subcontractor personnel often make up the majority of the site workforce, so subcontractor safety performance largely determines site safety performance.

    • Apply the same HSE rules to subcontractors as to the main contractor’s own staff.
    • Review subcontractor safety plans and risk assessments before work starts.
    • Verify competency for high-risk activities such as lifting, work at height, confined space, hot work, and energized work.
    • Include subcontractors in incident reporting, investigation, and lessons learned.
    • Address environmental and community obligations, including waste, noise, and local labor relations.

    Subcontractor Payment

    Subcontractor payment ensures that subcontractors are paid correctly and on time.

    Payment activities:

    • Payment schedule: What payments are due, and when?
    • Milestone and progress verification: Confirming that work has actually been completed and, where required, inspected and accepted.
    • Invoice review: Reviewing invoices for accuracy, supporting documents, and consistency with the subcontract.
    • Deductions and retention: Applying retention, backcharges, and advance payment recovery as the subcontract provides.
    • Payment approval and processing: Approving and processing payments within the agreed period.

    Payment should be made according to the subcontract terms. Late or disputed payments can lead to reduced manpower, slowed progress, and strained relationships, so payment certification should be fast, transparent, and based on verified progress.

    Subcontract Closeout

    Subcontract closeout is often neglected, yet it protects both parties.

    • Completion and punch list: Confirm completion, and close out punch list items and non-conformances.
    • Demobilization: Remove equipment, temporary works, and surplus materials, and restore areas.
    • Documentation: Collect as-built drawings, test records, certificates, and manuals for the turnover package.
    • Final account: Agree final measurement, variations, and outstanding claims, and release retention and bonds according to the subcontract.
    • Warranty: Confirm warranty obligations and contacts.
    • Lessons learned: Record the performance review and lessons for future projects.

    Subcontractor Management in Small Plants

    Small plants face particular challenges with subcontractor management.

    Challenges:

    • Fewer resources for subcontractor management.
    • Less expertise.
    • Less access to specialist subcontractors.
    • Competing priorities.

    Practical approaches:

    • Focus on critical subcontractors: Prioritize management of subcontractors whose work is on the critical path or carries high safety or quality risk.
    • Use simple tools: Simple checklists, logs, and weekly reports can be sufficient.
    • Use local subcontractors where suitable: Local subcontractors can reduce logistics and coordination complexity and bring local knowledge, provided competence and safety standards are verified.
    • Limit the number of interfaces: Bundle compatible scopes into fewer subcontracts where sensible.
    • Document everything: Good records support coordination and resolve disputes.
    • Train staff: Ensure staff understand subcontractor management requirements.
    • Learn from others: Apply lessons from other projects.

    Subcontractor management does not need to be complex. It needs to be thorough and consistent.

    Common Mistakes in Subcontractor Management

    Even experienced organizations make mistakes. Common ones include:

    • Poor subcontractor selection: Selecting subcontractors who cannot perform the work, or choosing on price alone.
    • Unclear subcontracts: Ambiguous scope or terms that lead to disputes.
    • Mismatch with the main contract: Obligations that are not flowed down, leaving the contractor exposed.
    • Inadequate mobilization: Subcontractors not ready to start work.
    • Poor supervision: Problems not identified and addressed.
    • Ineffective coordination: Conflicts between subcontractors over access, sequence, or shared resources.
    • Neglecting subcontractor safety: Treating subcontractor personnel as outside the project’s safety culture.
    • No performance management: Performance not monitored or managed.
    • Slow change and claim handling: Variations left unresolved until the end of the project.
    • Delayed payments: Subcontractors not paid on time.
    • Incomplete documentation: Records missing or incomplete.

    These mistakes are costly to correct. They are much cheaper to avoid through disciplined subcontractor management.

    How EPC Partners Inc. Approaches Subcontractor Management

    At EPC Partners Inc., we bring practical experience from projects across Asia, the Middle East, Africa, and Europe to subcontractor management. As a Japanese EPC support firm, we emphasize preparation, clear communication, and steady, detailed follow-through on site.

    Our approach includes:

    • Thorough selection: Subcontractors are prequalified and selected based on objective criteria.
    • Clear contracts: Subcontracts are clear, complete, and aligned with the main contract.
    • Careful mobilization: Procedures, personnel, and permits are checked before work fronts are released.
    • Disciplined supervision: Subcontractor work is supervised daily, with safety and quality checks.
    • Effective coordination: Interfaces, area handovers, and tie-ins are planned carefully.
    • Performance management: Subcontractor performance is monitored and managed.
    • Timely payment: Subcontractors are paid according to the subcontract terms on the basis of verified progress.
    • Detailed documentation: Records are complete and accurate.
    • Continuous improvement: Lessons are captured and applied.

    Our experience includes supporting geothermal projects in Kenya, Ethiopia, Indonesia, Iceland, and Japan; desalination projects in the UAE, Saudi Arabia, Oman, and Qatar; thermal power projects in Vietnam, Bangladesh, and Japan; and water treatment projects in Vietnam, Kuwait, and Qatar.

    We have also supported clients including Marubeni Corporation, Fuji Electric Co., Ltd., and Toyota Tsusho Corporation on subcontractor management aspects of their projects.

    How to Evaluate Subcontractor Management Readiness

    When reviewing subcontractor management, ask:

    Question Why It Matters
    Are subcontractors prequalified and selected on objective criteria? Ensures capable subcontractors
    Are subcontracts clear, complete, and aligned with the main contract? Prevents disputes and unmanaged risk
    Are subcontractors mobilized effectively? Ensures work starts on time and safely
    Are subcontractors supervised? Ensures work meets requirements
    Are subcontractors coordinated? Prevents conflicts
    Is subcontractor safety managed? Protects people and the project
    Is subcontractor performance managed? Ensures performance meets requirements
    Are changes and claims handled promptly? Avoids end-of-project disputes
    Are subcontractors paid on time? Maintains relationships and manpower
    Is closeout planned and documentation complete? Supports handover, warranty, and disputes

    A project that addresses these questions is ready for effective subcontractor management.

    Conclusion

    Subcontractor management is critical to plant success. For small to medium-scale industrial plants, it determines whether construction proceeds safely, on time, and to the required quality.

    By focusing on subcontractor selection, contracting, mobilization, supervision, coordination, performance management, payment, and closeout, owners and project teams can ensure that subcontractors deliver their work successfully.

    If you are planning a plant project and need support with subcontractor management or EPC project delivery, contact us to discuss how we can help.

    EPC Partners Inc. is a Japanese EPC support firm with experience supporting power, water, and industrial plant projects across Asia, the Middle East, Africa, and Europe. For more information, visit our project list.

  • Plant Site Management: Key Practices for EPC Projects

    Plant Site Management: Key Practices for EPC Projects

    A construction site is a complex, dynamic environment. Hundreds of workers, heavy equipment, materials, and multiple contractors occupy the same space, often in remote locations with limited infrastructure. Site management is the discipline of organizing, coordinating, and controlling everything that happens on site, ensuring that work proceeds safely, efficiently, and in accordance with the project plan.

    At EPC Partners Inc., site management has been a core part of our work across a wide range of plant projects: geothermal power plants in Kenya, Indonesia, and Iceland; large-scale desalination facilities in the UAE and Saudi Arabia; thermal power plants in Vietnam and Bangladesh; and water treatment plants in Vietnam and Kuwait. Each project has presented different site management challenges, and each has reinforced the same lesson: good site management is not just about giving instructions. It is about creating the conditions for work to proceed safely and efficiently, and resolving problems before they escalate.

    This article covers the key practices in plant site management, drawing on our experience supporting projects across Asia, the Middle East, Africa, and Europe.

    What Is Site Management?

    Site management is the discipline of organizing, coordinating, and controlling activities on a construction site. It includes:

    • Site organization: Setting up the site, including offices, laydown areas, and access.
    • Safety management: Ensuring that work is performed safely.
    • Quality management: Ensuring that work meets specifications.
    • Progress management: Tracking and controlling progress.
    • Coordination: Coordinating disciplines, contractors, and activities.
    • Resource management: Managing labor, equipment, and materials.
    • Environmental management: Controlling the impact of construction on air, water, soil, noise, and ecology.
    • Stakeholder management: Managing relationships with the local community, regulators, and other stakeholders.

    Site management ensures that construction proceeds safely, efficiently, and in accordance with the project plan.

    Why Site Management Matters

    Site management directly affects project success.

    Factor Impact of Good Site Management Impact of Poor Site Management
    Safety Incidents prevented Incidents and injuries
    Quality Work meets specifications Rework and defects
    Schedule Work completed on time Delays and inefficiency
    Cost Costs controlled Cost overruns
    Coordination Disciplines work together Conflicts and confusion
    Environment Impacts controlled and permit conditions met Violations, fines, and stop-work orders
    Community Community supports the project Community opposition

    For small to medium-scale industrial plants, site management determines whether construction proceeds smoothly.

    The Site Management Team

    Site management works only when roles are clear. A typical site organization includes:

    • Site manager / construction manager: Overall responsibility for site activities, safety, progress, and coordination.
    • Construction supervisors and discipline leads: Direct supervision of civil, mechanical, piping, electrical, and instrumentation work.
    • HSE manager and officers: Safety, health, and environmental management, including inspections and training.
    • QA/QC engineer or inspectors: Inspection, testing, and non-conformance management.
    • Planner / progress engineer: Progress measurement, reporting, and look-ahead schedules.
    • Document controller: Drawings, transmittals, and site records.
    • Materials and logistics coordinator: Receiving, storage, and issue of materials and equipment.
    • Community liaison officer: Day-to-day contact with local communities and authorities.

    On small projects, one person may cover several roles. What matters is that every responsibility has a named owner.

    Site Organization

    Site organization layout for an industrial plant construction site

    Site organization is the process of setting up the site for construction.

    Site organization activities:

    • Site layout: Planning the layout of offices, laydown areas, access roads, and utilities.
    • Site facilities: Providing offices, warehouses, workshops, and welfare facilities.
    • Site access: Establishing access roads, gates, and traffic routes, with separation of vehicles and pedestrians.
    • Site security: Providing security to protect people and assets.
    • Site utilities: Providing power, water, sanitation, and communications.
    • Drainage and ground conditions: Managing stormwater and ground conditions so that the site remains workable in bad weather.

    Site organization should be planned before construction begins, and the layout should be reviewed as the project moves from civil works to mechanical erection and then to commissioning, because space needs change at each phase.

    At our geothermal projects in Kenya (Olkaria I Unit 6, 83 MW) and Indonesia (Muara Laboh, 85.2 MW), site organization included careful planning of laydown areas and access roads in remote, difficult terrain. In Iceland (Theistareykir, 2×45 MW), site organization considered the short construction season and the need for efficient site logistics.

    Project experience: At one geothermal project in Kenya, the remote site location required careful planning of laydown areas and access roads, with materials stockpiled before the rainy season to avoid delays. At another project in Indonesia, the difficult terrain required specialized access roads and crane pads to enable construction in steep, volcanic conditions.

    Mobilization and Site Establishment

    The first weeks on site set the pattern for the whole project. Effective mobilization includes:

    • Confirming site access, land rights, and permits before mobilizing.
    • Establishing temporary offices, welfare facilities, and first-aid and emergency arrangements before large work crews arrive.
    • Setting up site induction so that every worker and visitor is briefed before entering the work area.
    • Agreeing on reporting formats, meeting schedules, and communication channels with all contractors.
    • Surveying and recording the pre-construction condition of the site and surrounding roads and structures, which protects the project in later disputes.

    Safety Management

    Safety is the highest priority in site management.

    Safety management activities:

    • Hazard identification: Identifying site hazards.
    • Risk assessment: Assessing the risks of site activities.
    • Safety procedures: Developing and implementing safety procedures.
    • Safety training and induction: Training workers on safety requirements before they start work.
    • Safety inspections: Regular inspections to identify hazards.
    • Incident reporting: Reporting and investigating incidents, including near misses.
    • Emergency response: Planning for emergencies, including medical evacuation from remote locations.

    Safety management should be proactive: identifying and addressing hazards before they cause incidents.

    High-risk activities

    Some activities need particular control on every plant project:

    • Permit-to-work system: Hot work, confined space entry, excavation, energized work, and work at height should require a permit, issued only after the hazards and controls have been checked on site.
    • Lifting operations: Lifting plans, certified equipment and operators, exclusion zones, and wind limits for heavy lifts.
    • Work at height: Scaffolding inspection, fall protection, and control of falling objects.
    • Excavation and ground work: Identification of underground services, shoring, and edge protection.
    • Electrical safety: Lock-out/tag-out and control of temporary power.
    • Traffic and equipment movement: Defined routes, banksmen, and speed limits.
    • Simultaneous operations: Control of overlapping work in the same area, especially during commissioning when parts of the plant become live.

    For thermal power projects in Vietnam (Thai Binh 1, 2×300 MW) and Bangladesh (Bibiyana-III, 400 MW CCGT), safety management included daily safety briefings, regular safety inspections, and a strong safety culture that emphasized personal responsibility and hazard reporting.

    Japanese practices

    Japanese EPC practice brings a number of habits to site safety that translate well to international projects: morning assemblies with toolbox meetings, hazard prediction activities (known in Japan as KY, kiken yochi) before each task, and disciplined housekeeping through 5S (sort, set in order, shine, standardize, sustain). These are simple, low-cost practices, but they keep hazard awareness visible every day.

    Quality Management

    Quality management ensures that work meets specifications.

    Quality management activities:

    • Quality planning: Defining quality requirements and how they will be achieved.
    • Inspection and testing: Inspecting and testing work as it is completed.
    • Non-conformance management: Identifying and resolving non-conformances.
    • Documentation: Recording inspections, tests, and non-conformances.

    Quality management should be based on inspection and test plans (ITPs) and should be integrated with construction activities. Hold points and witness points should be agreed in advance, so that critical work (such as concrete pours, welding, pressure tests, and cable terminations) is not covered up before it is inspected. Quality records should be built progressively during construction, not assembled at the end.

    Progress Management

    Progress management tracks and controls progress against the schedule.

    Progress management activities:

    • Progress measurement: Measuring actual progress against the plan, using agreed methods such as quantities installed or weighted milestones.
    • Progress reporting: Reporting progress to project management through daily, weekly, and monthly reports.
    • Look-ahead planning: Preparing short-term (typically two to four week) look-ahead schedules that identify what is needed for upcoming work: drawings, materials, equipment, labor, and permits.
    • Variance analysis: Identifying and analyzing variances.
    • Corrective action: Taking corrective action to recover slippage.

    Progress management should be based on accurate data and regular reporting. Progress that is over-reported early in the project often becomes a serious problem later, so measurement rules should be agreed and applied consistently.

    Coordination

    Coordination ensures that disciplines, contractors, and activities work together.

    Coordination activities:

    • Interface management: Managing interfaces between disciplines and contractors.
    • Coordination meetings: Regular meetings to coordinate work, with actions recorded and followed up.
    • Area-based planning: Planning work by area to manage interfaces.
    • Handover procedures: Defining how areas are handed over between contractors.

    Coordination is especially important in complex projects with multiple contractors.

    For desalination projects in the Gulf (Taweelah, 909,200 m³/day; Jubail 3A, 600,000 m³/day), coordination included the interface between the marine works contractor, the process plant contractor, and the electrical and instrumentation contractor, with careful planning of tie-ins and handovers.

    Subcontractor Management

    Most of the work on a plant site is performed by subcontractors, so the main contractor’s site management is only as strong as its control of them. Key practices:

    • Require subcontractors to comply with the project safety, quality, and environmental procedures, and verify compliance on site.
    • Check competence and certification of key personnel, welders, riggers, and equipment operators before work starts.
    • Agree clear scopes and interfaces, so that gaps and overlaps between subcontractors are identified early.
    • Hold subcontractors to the same reporting and meeting discipline as the main contractor’s own teams.
    • Address performance problems early, before they affect the critical path.

    Resource Management

    Resource management ensures that labor, equipment, and materials are available when needed.

    Resource management activities:

    • Labor management: Ensuring that adequate, qualified labor is available, including accommodation, transport, and welfare where needed.
    • Equipment management: Ensuring that equipment is available, inspected, and maintained.
    • Materials management: Ensuring that materials are received, inspected, stored correctly, and issued when needed.

    Resource management should be planned to avoid shortages and delays. On remote sites, storage conditions, protection of sensitive equipment (such as electrical gear, instruments, and rotating machinery), and buffer stocks of critical materials deserve particular attention.

    Environmental Management

    Construction can affect air quality, water, soil, noise, and local ecology. Site environmental management should follow the project’s environmental permits and management plan, and typically includes:

    • Dust, noise, and vibration control.
    • Stormwater and erosion control, and protection of nearby watercourses.
    • Waste segregation, storage, and disposal through approved routes.
    • Storage and handling of fuels and chemicals, with spill prevention and response equipment.
    • Protection of sensitive habitats and cultural heritage, where applicable.
    • Regular monitoring and records, so that compliance can be demonstrated to regulators and lenders.

    Stakeholder Management

    Stakeholder management manages relationships with the local community, regulators, and other stakeholders.

    Stakeholder management activities:

    • Community engagement: Engaging with the local community, including local employment and procurement where possible.
    • Regulator engagement: Engaging with regulators and arranging inspections and approvals in good time.
    • Grievance mechanisms: Providing a way for stakeholders to raise concerns.
    • Communication: Keeping stakeholders informed, including advance notice of heavy traffic, blasting, or other disruptive work.

    Stakeholder management should be proactive and transparent.

    Site Security and Records

    Security. Site security protects people, materials, and equipment. Practices include controlled access with worker and visitor registration, perimeter fencing, secure storage for high-value items, and coordination with local authorities where appropriate.

    Site records. Good records support coordination, claims, and handover. Core site records include:

    • Daily site diaries and daily progress reports.
    • Inspection and test records, and non-conformance reports.
    • Safety records: inductions, toolbox talks, inspections, permits, and incident reports.
    • Material receiving and inspection records.
    • Instructions, variations, and correspondence with the client and subcontractors.
    • Photographs of key activities and of work that will be covered up.
    • As-built information, marked up progressively as work is completed.

    Completion, Commissioning Interface, and Demobilization

    Site management does not end when construction is mechanically complete. In the final phase:

    • Construction and commissioning teams should agree on system-by-system turnover, so that completed systems are handed over in a defined, documented way.
    • Safety control becomes even more important as systems are energized and pressurized, with clear isolation and permit procedures between construction and commissioning work.
    • Punch lists should be managed actively, with categories, owners, and deadlines.
    • Final documentation, including as-built drawings and quality records, should be completed and handed over.
    • Temporary facilities should be removed and the site restored in accordance with contract and permit requirements.
    • Lessons learned should be recorded for use on future projects.

    Site Management in Small Plants

    Small plants face particular challenges with site management.

    Challenges:

    • Fewer resources for site management.
    • Less expertise.
    • Less access to specialist support.
    • Competing priorities.

    Practical approaches:

    • Focus on critical activities: Prioritize management of critical activities.
    • Use simple tools: Simple checklists and logs can be sufficient.
    • Use third-party support: Leverage third-party support for specialized work.
    • Document everything: Good records support coordination and disputes.
    • Train staff: Ensure staff understand site management requirements.
    • Learn from others: Apply lessons from other projects.

    Site management does not need to be complex. It needs to be thorough and consistent.

    Common Mistakes in Site Management

    Even experienced organizations make mistakes. Common ones include:

    • Inadequate site planning: Site not properly organized.
    • Poor safety management: Incidents and injuries.
    • Weak quality management: Rework and defects.
    • Poor progress management: Delays not identified.
    • Ineffective coordination: Conflicts between disciplines and contractors.
    • Weak subcontractor control: Subcontractors working outside agreed procedures.
    • Resource shortages: Labor, equipment, or materials not available.
    • Neglected environmental controls: Permit breaches and stop-work orders.
    • Poor stakeholder management: Community or regulator opposition.
    • Incomplete documentation: Records missing or incomplete.

    These mistakes are costly to correct. They are much cheaper to avoid through disciplined site management.

    How EPC Partners Inc. Approaches Site Management

    At EPC Partners Inc., we bring practical experience from projects across Asia, the Middle East, Africa, and Europe to site management.

    Our approach includes:

    • Safety focus: Safety is prioritized throughout construction.
    • Quality focus: Work is inspected as it is completed.
    • Progress monitoring: Progress is tracked and reported regularly.
    • Coordination: Disciplines and contractors are coordinated carefully.
    • Resource management: Resources are planned and managed effectively.
    • Environmental and stakeholder management: Environmental impacts are controlled and stakeholders are engaged constructively.
    • Detailed documentation: Records are complete and accurate.
    • Continuous improvement: Lessons are captured and applied.

    Our experience includes supporting geothermal projects in Kenya, Ethiopia, Indonesia, Iceland, and Japan; desalination projects in the UAE, Saudi Arabia, Oman, and Qatar; thermal power projects in Vietnam, Bangladesh, and Japan; and water treatment projects in Vietnam, Kuwait, and Qatar.

    We have also supported clients including Marubeni Corporation, Fuji Electric Co., Ltd., and Toyota Tsusho Corporation on site management aspects of their projects.

    How to Evaluate Site Management Readiness

    When reviewing site management, ask:

    Question Why It Matters
    Is the site organized? Provides the foundation for construction
    Are roles and responsibilities clear? Ensures every task has an owner
    Is safety management in place, including permit-to-work? Protects workers
    Is quality management in place? Ensures work meets specifications
    Is progress monitored? Identifies delays early
    Is coordination effective, including subcontractors? Prevents conflicts
    Are resources managed? Ensures resources are available
    Are environmental controls in place? Prevents violations and stop-work orders
    Are stakeholders engaged? Prevents opposition
    Is documentation complete? Supports handover and operations

    A project that addresses these questions is ready for effective site management.

    Key Takeaways

    • Plan the site before construction begins, and revisit the layout as the project phases change.
    • Make safety the first priority, with permit-to-work and daily hazard awareness.
    • Inspect work as it is completed, based on agreed ITPs.
    • Measure progress consistently and plan short-term look-aheads.
    • Control subcontractors and interfaces actively.
    • Keep complete, accurate records from the first day.

    Conclusion

    Site management is critical to plant success. For small to medium-scale industrial plants, it determines whether construction proceeds safely, efficiently, and in accordance with the project plan.

    By focusing on site organization, safety management, quality management, progress management, coordination, resource management, environmental management, and stakeholder management, owners and project teams can ensure that construction proceeds smoothly and the plant is built safely and to the required quality.

    If you are planning a plant project and need support with site management or EPC project delivery, contact us to discuss how we can help.

    EPC Partners Inc. is a Japanese EPC support firm with experience supporting power, water, and industrial plant projects across Asia, the Middle East, Africa, and Europe. For more information, visit our project list.

  • Plant Logistics and Materials Management: Key Practices for EPC Projects

    Plant Logistics and Materials Management: Key Practices for EPC Projects

    Every industrial plant project depends on materials arriving at the right place, at the right time, and in the right condition. Steel, pipe, valves, cable, equipment, and instruments must be sourced, shipped, received, stored, and issued to construction, often across international borders and remote sites. Logistics and materials management is the discipline of making this happen efficiently and reliably.

    At EPC Partners Inc., logistics and materials management have been a core part of our work across a wide range of plant projects. They include geothermal power plants in Kenya, Indonesia, and Iceland, large-scale desalination facilities in the UAE and Saudi Arabia, thermal power plants in Vietnam and Bangladesh, and water treatment plants in Vietnam and Kuwait. Our logistics work has ranged from remote geothermal sites in Kenya and Indonesia, where road access was limited and materials had to be stockpiled before the rainy season, to large-scale desalination projects in the Gulf, where sea freight and customs clearance required careful coordination. Each project has reinforced the same lesson: logistics is not just about moving materials. It is about anticipating problems, planning ahead, and ensuring that construction is never held up by missing materials.

    This article covers the key practices in plant logistics and materials management, drawing on our experience supporting projects across Asia, the Middle East, Africa, and Europe.

    What Is Logistics and Materials Management?

    Logistics and materials management is the discipline of planning, sourcing, shipping, receiving, storing, and issuing materials for a project. It includes:

    • Procurement logistics: Sourcing and shipping materials from vendors.
    • Inbound logistics: Receiving materials at site or warehouse.
    • Materials management: Storing, preserving, and issuing materials.
    • Site logistics: Moving materials around the site.
    • Outbound logistics: Removing surplus, waste, and equipment.

    Together these ensure that materials are available when needed and in good condition.

    Why Logistics and Materials Management Matter

    Factor Impact of Good Logistics Impact of Poor Logistics
    Schedule Materials available when needed Construction delayed by missing materials
    Cost Efficient logistics; lower costs Higher costs from delays, demurrage, and emergency purchases
    Quality Materials stored and preserved correctly Materials damaged or degraded
    Safety Materials handled and stored safely Safety incidents
    Space Efficient use of site space Congested site; inefficient operations
    Documentation Complete records of materials Missing or incomplete records

    For small to medium-scale industrial plants, logistics and materials management often determine whether construction proceeds smoothly.

    Logistics Planning

    Logistics planning defines how materials will be sourced, shipped, received, stored, and issued. Key planning activities:

    • Define logistics scope: What materials and equipment are involved, including heavy, oversized, hazardous, and sensitive items?
    • Define logistics routes: How will materials be shipped, and through which ports and roads?
    • Define logistics schedule: When must materials arrive? Work back from the construction schedule using required-on-site (ROS) dates.
    • Define storage requirements: What storage and laydown areas are needed?
    • Define handling requirements: What cranes, lifting equipment, and permits are needed?
    • Define responsibilities: Who is responsible for each activity, including the freight forwarder, vendors, and site team?
    • Define contingencies: What if materials are delayed or damaged?

    Logistics planning should be integrated into the overall project schedule and aligned with procurement and construction sequencing.

    At our geothermal projects in Kenya (Olkaria I Unit 6, 83 MW) and Indonesia (Muara Laboh, 85.2 MW), logistics planning considered the remote site locations, limited road access, and the need to coordinate deliveries with construction progress. In Iceland (Theistareykir, 2×45 MW), it considered the short construction season and the need to stockpile materials before winter.

    Procurement Logistics

    Procurement logistics is the process of sourcing and shipping materials from vendors. Key activities:

    • Vendor coordination: Agreeing delivery schedules, packing requirements, and shipping documents with vendors. This links closely to vendor inspection and expediting.
    • Delivery terms: Defining the responsibilities of buyer and seller. Incoterms (for example FOB, CIF, DAP) should be chosen deliberately, because they determine who bears cost, risk, and insurance at each stage.
    • Shipping arrangements: Arranging transport from vendor to site, often through a freight forwarder.
    • Customs clearance: Managing import and export procedures.
    • Insurance: Insuring goods during transport.
    • Tracking: Monitoring shipment progress against the schedule.
    • Documentation: Preparing shipping documents.

    Procurement logistics should be planned to avoid delays and damage.

    Shipping and Transport

    Shipping and transport modes for EPC projects

    Shipping and transport move materials from vendors to site.

    Mode Description When to Use
    Road Trucks and trailers Most materials, short to medium distances
    Rail Trains Bulk materials, long distances
    Sea Ships and barges Heavy equipment, international shipments
    Air Aircraft Urgent or high-value items

    The choice of mode depends on the material, distance, cost, and urgency.

    Heavy and oversized equipment such as turbines, generators, transformers, and large vessels needs special attention. A route survey should confirm that roads, bridges, ports, and site access can carry the loads, and that permits, escorts, and lifting equipment are arranged. Packing and marking should follow vendor and project requirements, and dangerous goods must be classified, packed, and documented according to applicable regulations.

    For desalination projects in the Gulf (Taweelah, 909,200 m³/day; Jubail 3A, 600,000 m³/day), shipping included sea freight for high-pressure pumps, membrane skids, and energy recovery devices.

    Project anecdotes

    At one desalination project in the Gulf, sea freight for high-pressure pumps and membrane skids required careful coordination of port arrival, customs clearance, and transport to site, with all deliveries sequenced to match the construction schedule.

    At one geothermal project in Kenya, the remote site location required stockpiling materials before the rainy season, with a dedicated laydown area and materials tracking system.

    Customs Clearance

    Customs clearance is the process of clearing materials through customs. Key activities:

    • Documentation: Preparing customs documents (invoices, packing lists, certificates of origin, and, where needed, permits and certificates).
    • Classification: Using correct tariff codes and accurate descriptions. Errors here are a common cause of hold-ups.
    • Duties and taxes: Paying applicable duties and taxes, and applying any available exemptions.
    • Inspection: Customs inspection of materials.
    • Release: Release of materials from customs.

    Customs clearance can be a significant source of delay, especially for international shipments. Start the process early and make sure vendor documents are complete and consistent before the shipment leaves.

    Receiving and Inspection

    Receiving and inspection ensure that materials arrive in good condition. Key activities:

    • Receiving: Receiving materials at site or warehouse against purchase orders and packing lists.
    • Inspection: Checking for damage, shortages, and correct identification, including a visual check of packing and shock or tilt indicators where fitted.
    • Documentation: Recording receipt and inspection results, for example in a material receiving report.
    • Discrepancy reporting: Reporting overages, shortages, and damage (OS&D) to the vendor, forwarder, and insurer promptly, because claim deadlines are often short.

    Receiving and inspection should be documented and followed up promptly.

    Storage and Preservation

    Storage and preservation ensure that materials remain in good condition until needed. Key activities:

    • Storage areas: Designated areas for different material types, including laydown yards, covered storage, and warehouses.
    • Storage methods: Racking, stacking, and shelving, with a location system so that items can be found quickly.
    • Preservation: Protection from moisture, corrosion, and damage, following vendor preservation instructions.
    • Environmental control: Temperature and humidity control where required.
    • Security: Protection from theft and vandalism.

    For thermal power projects in Vietnam (Thai Binh 1, 2×300 MW) and Bangladesh (Bibiyana-III, 400 MW CCGT), storage and preservation included covered storage for sensitive equipment, climate-controlled storage for instruments, and preservation of rotating equipment with periodic rotation and lubrication.

    Materials Handling

    Materials handling is the process of moving materials around the site. Typical equipment:

    • Cranes: For lifting heavy equipment.
    • Forklifts: For moving pallets and materials.
    • Trucks: For transporting materials around site.
    • Conveyors: For moving bulk materials.

    Handling should be planned for safety and efficiency, with lifting plans for heavy lifts, trained and certified operators, and traffic management on congested sites.

    Materials Tracking and Control

    Good tracking is what turns a delivery schedule into a reliable plan. A materials register, or a materials management system for larger projects, should link purchase orders, shipments, receipts, storage locations, and issues. It should be updated promptly, and it should compare forecast delivery dates with ROS dates so that risks are visible early.

    Materials Issue

    Materials issue is the process of delivering materials to construction. Key activities:

    • Requisition: Construction requests materials.
    • Picking: Materials are picked from storage.
    • Issue: Materials are issued to construction.
    • Documentation: Issue is recorded.

    Materials issue should be controlled to prevent loss and ensure traceability, including material certificates where required for quality records.

    Surplus and Waste Management

    Surplus and waste management is the process of managing excess materials and waste, and forms the project’s outbound logistics. Key activities:

    • Surplus identification: Identifying surplus materials, ideally before project completion.
    • Disposition: Returning, reselling, transferring to the owner as spares, or disposing of surplus.
    • Waste management: Managing construction waste, including hazardous waste, in line with project and regulatory requirements.
    • Recycling: Recycling materials where possible.
    • Demobilization: Removing temporary facilities and construction equipment.

    Logistics and Materials Management in Small Plants

    Small plants face particular challenges: fewer resources for logistics, less expertise, less access to logistics infrastructure, and competing priorities. Practical approaches include:

    • Focus on critical materials: Prioritize logistics for long-lead and critical items.
    • Use simple tools: Simple materials registers and logs can be sufficient.
    • Use local suppliers: Local suppliers reduce logistics complexity.
    • Plan ahead: Plan logistics well in advance to avoid delays.
    • Document everything: Good records support claims and disputes.
    • Learn from others: Apply lessons from other projects.

    Logistics and materials management do not need to be complex. They need to be thorough and consistent.

    Measuring Logistics Performance

    Simple indicators help teams spot problems early:

    • Percentage of deliveries on time against ROS dates
    • Number and value of OS&D reports
    • Customs clearance time
    • Inventory accuracy
    • Time from requisition to issue
    • Storage damage or loss incidents

    Reviewing these regularly allows corrective action before construction is affected.

    Common Mistakes in Logistics and Materials Management

    • No logistics plan: Logistics left to chance.
    • Late deliveries: Materials arrive too late for construction.
    • Unclear delivery terms: Responsibility and risk not defined.
    • Incomplete shipping or customs documents: Delays at ports.
    • Poor storage: Materials damaged or degraded.
    • Inadequate handling: Safety incidents or damage.
    • No materials traceability: Materials cannot be traced to their source.
    • Poor documentation: Records missing or incomplete.
    • No surplus management: Surplus materials accumulate.
    • No waste management: Waste accumulates and becomes a problem.

    These mistakes are costly to correct and much cheaper to avoid through disciplined logistics and materials management.

    How EPC Partners Inc. Approaches Logistics and Materials Management

    We bring practical experience from projects across Asia, the Middle East, Africa, and Europe. Our approach includes:

    • Thorough planning: Logistics is planned from the beginning, with clear schedules and contingencies.
    • Disciplined tracking: Materials are tracked through a materials register.
    • Quality focus: Materials are inspected on receipt and stored correctly.
    • Safety focus: Materials are handled and stored safely.
    • Detailed documentation: Records are complete and accurate.
    • Continuous improvement: Lessons are captured and applied.

    Our experience includes supporting geothermal projects in Kenya, Ethiopia, Indonesia, Iceland, and Japan; desalination projects in the UAE, Saudi Arabia, Oman, and Qatar; thermal power projects in Vietnam, Bangladesh, and Japan; and water treatment projects in Vietnam, Kuwait, and Qatar. We have also supported clients including Marubeni Corporation, Fuji Electric Co., Ltd., and Toyota Tsusho Corporation on logistics and materials management aspects of their projects.

    How to Evaluate Logistics and Materials Management Readiness

    Question Why It Matters
    Is there a logistics plan with ROS dates? Provides a roadmap for logistics
    Are delivery terms and responsibilities defined? Clarifies risk, cost, and insurance
    Are materials tracked? Ensures materials are available when needed
    Are shipping and customs documents complete? Prevents delays at ports
    Are materials inspected on receipt? Ensures materials are in good condition
    Are materials stored correctly? Keeps materials in good condition
    Are materials handled safely? Prevents safety incidents
    Is documentation complete? Supports traceability and claims
    Is surplus and waste managed? Minimizes waste and reduces costs

    A project that addresses these questions is ready for effective logistics and materials management.

    Conclusion

    Logistics and materials management are critical to plant success. For small to medium-scale industrial plants, they determine whether materials arrive on time and in good condition.

    By focusing on logistics planning, procurement logistics, shipping and transport, customs clearance, receiving and inspection, storage and preservation, materials handling, tracking, materials issue, and surplus and waste management, owners and project teams can ensure that logistics supports the project throughout its life.

    EPC Partners Inc. is a Japanese EPC support firm with experience supporting power, water, and industrial plant projects across Asia, the Middle East, Africa, and Europe. If you are planning a plant project and need support with logistics or EPC project delivery, contact us to discuss how we can help. For more information, visit our project list.

  • Plant Vendor Inspection and Expediting: Key Practices for EPC Projects

    Plant Vendor Inspection and Expediting: Key Practices for EPC Projects

    Vendor inspection and expediting are the disciplines that ensure equipment arrives on time and meets specifications. Inspection verifies that equipment is manufactured correctly before it leaves the vendor’s facility. Expediting monitors vendor progress and intervenes when delays threaten the project schedule. Together, they protect the project from the two most common procurement failures: late delivery and poor quality.

    At EPC Partners Inc., vendor inspection and expediting have been a core part of our work across a wide range of plant projects, from geothermal power plants in Kenya, Indonesia, and Iceland to large-scale desalination facilities in the UAE and Saudi Arabia, and from thermal power plants in Vietnam and Bangladesh to water treatment plants in Vietnam and Kuwait. Our inspection and expediting work has ranged from geothermal projects in Kenya and Indonesia, where corrosion-resistant materials required careful verification, to desalination projects in the Gulf, where high-pressure pumps and membrane skids were inspected at source before shipment.

    Each project has presented different challenges, and each has reinforced the same lesson: vendor inspection and expediting are not just about checking boxes. They are about building relationships with vendors, understanding their capabilities, and intervening early when problems arise.

    This article covers the key practices in plant vendor inspection and expediting, drawing on our experience supporting projects across Asia, the Middle East, Africa, and Europe.

    What Is Vendor Inspection and Expediting?

    Vendor inspection is the process of verifying that equipment is manufactured to the contract specifications, applicable codes, and approved drawings before it is shipped.

    Vendor expediting is the process of monitoring vendor progress against the purchase order schedule and intervening to keep deliveries on track.

    The two disciplines work best together. Inspection findings often explain schedule slippage (rework, failed tests, material problems), and schedule pressure can tempt vendors to cut corners on quality. A coordinated approach keeps both under control.

    Why Vendor Inspection and Expediting Matter

    Vendor inspection and expediting directly affect project success.

    Factor Impact of Good Inspection and Expediting Impact of Poor Inspection and Expediting
    Quality Equipment meets specifications Defective equipment arrives at site
    Schedule Equipment arrives on time Delays cascade to construction
    Cost Rework and delays avoided Rework, demurrage, and delay costs
    Safety Equipment is safe to install and operate Safety hazards from defective equipment
    Integration Equipment integrates with the plant Interface problems
    Warranty Clear records of inspection and testing Disputes over warranty coverage

    Problems found at the vendor’s works are far cheaper to fix than problems found at site. A dimensional error corrected in the shop costs hours; the same error discovered during installation can cost weeks. For small to medium-scale industrial plants, vendor inspection and expediting determine whether equipment arrives on time and meets specifications.

    Vendor Inspection Planning

    Vendor inspection planning defines what inspections are required, when, and by whom.

    Inspection planning activities:

    • Define inspection requirements: What inspections are required for each equipment item?
    • Define inspection levels: Full inspection, sampling inspection, witness testing, or documentation review?
    • Define inspection criteria: What standards and specifications apply?
    • Define inspection responsibilities: Who performs and witnesses the inspection?
    • Define inspection schedule: When will inspections occur, and how will they be coordinated with the vendor’s production schedule?
    • Define documentation: What records will be produced?

    Inspection planning should be based on equipment criticality and risk. A useful starting point is a criticality ranking of every purchase order, considering factors such as safety consequence, effect on plant availability, lead time, complexity, and the vendor’s track record.

    At our geothermal projects in Kenya (Olkaria I Unit 6, 83 MW) and Indonesia (Muara Laboh, 85.2 MW), inspection planning for steam turbines included witness testing of performance and material verification for corrosion-resistant components. In Iceland (Theistareykir, 2×45 MW), inspection planning considered the seismic and environmental requirements of the site.

    Inspection and Test Plans (ITPs)

    Inspection and test plans (ITPs) define the inspections and tests required for each equipment item.

    Element Description
    Activity What work is being inspected
    Inspection/test What inspection or test is required
    Reference What standard or specification applies
    Acceptance criteria What defines acceptable quality
    Responsibility Who performs and witnesses the inspection
    Hold points Points where work cannot proceed without inspection and release
    Witness points Points where the inspector is notified and may attend, but work can proceed if the inspector does not attend
    Records What records are produced

    ITPs should be agreed with the vendor before manufacturing begins, and vendor ITPs should be reviewed against the purchase order requirements. Agreeing on hold and witness points early avoids disputes later, because the vendor knows in advance when production must pause and how much notice the inspector needs.

    Inspection Levels

    Vendor inspection levels for EPC projects

    Inspection levels determine how much inspection is performed.

    Level Description When to Use
    Full inspection Every item inspected Critical equipment
    Sampling inspection A sample of items inspected Standard equipment
    Witness testing Specific tests witnessed Equipment with critical performance requirements
    Documentation review Records reviewed without physical inspection Low-risk equipment

    Inspection levels should be based on equipment criticality and risk, and they can be adjusted as experience with a vendor builds. A vendor with a strong record may justify lighter inspection; early problems justify more.

    Vendor Expediting

    Vendor expediting monitors vendor progress and intervenes when delays threaten the project schedule.

    Expediting activities:

    • Progress monitoring: Tracking vendor progress against the schedule.
    • Milestone verification: Confirming that milestones (material orders, machining, assembly, testing, painting, packing) are actually met, not just reported.
    • Document tracking: Monitoring submission and approval of vendor drawings and data, since late document approvals are a frequent cause of delay.
    • Issue resolution: Identifying and resolving problems.
    • Reporting: Reporting progress and issues to project management.
    • Escalation: Escalating issues that cannot be resolved at the working level.
    • Sub-supplier monitoring: Monitoring sub-suppliers, where delays often originate.

    Expediting is especially important for long-lead items, where delays have the greatest impact. Expediting effort should be prioritized by schedule criticality, so that items on or near the critical path receive the closest attention.

    For thermal power projects in Vietnam (Thai Binh 1, 2×300 MW) and Bangladesh (Bibiyana-III, 400 MW CCGT), expediting included regular progress reviews with turbine and generator vendors, with early identification of potential delays and proactive intervention to keep delivery on track.

    Kick-Off Meetings

    Kick-off meetings set expectations with vendors at the start of the order.

    Kick-off meeting topics:

    • Scope: What is being supplied?
    • Schedule: What are the key milestones and delivery dates?
    • Quality: What are the quality requirements and ITPs?
    • Documentation: What documentation is required and when?
    • Communication: Who are the points of contact?
    • Reporting: What progress reports are required and how often?
    • Inspection: What inspections are required and when?
    • Sub-suppliers: Which sub-suppliers are involved, and what approvals apply?

    Kick-off meetings should be held for all major equipment orders. For critical equipment, they are best held at the vendor’s facility, where the team can see the shop, the planned sequence of work, and the people responsible.

    Progress Reporting

    Progress reporting keeps project management informed of vendor progress.

    Progress report contents:

    • Overall status: On track, at risk, or delayed?
    • Milestones: Status of key milestones, with planned and actual dates.
    • Issues: Any issues or risks?
    • Actions: What actions are being taken, by whom, and by when?
    • Forecast: Predicted delivery date.
    • Photographs and evidence: Where possible, supporting evidence of actual progress.

    Progress reports should be regular and accurate. Reports that always say “on track” until the final weeks are a warning sign; physical verification of progress through visits or inspection reports is the best check.

    Inspection at Source

    Inspection at source verifies equipment before it leaves the vendor’s facility.

    Inspection at source activities:

    • Pre-inspection meeting: Reviewing inspection requirements with the vendor.
    • In-process inspection: Inspecting during manufacturing, when defects are easiest to correct.
    • Final inspection: Inspecting before shipment, including packing and preservation.
    • Witness testing: Witnessing tests specified in the contract, such as factory acceptance tests (FATs), hydrostatic tests, and performance tests.
    • Documentation review: Reviewing material certificates, test certificates, and quality records.
    • Release for shipment: Issuing an inspection release note or certificate only when all requirements are met.

    Inspection at source prevents defective equipment from arriving at site.

    For desalination projects in the Gulf (Taweelah, 909,200 m³/day; Jubail 3A, 600,000 m³/day), inspection at source included the inspection of high-pressure pumps, membrane skids, and energy recovery devices, with witness testing of performance and material verification before shipment.

    Lessons from the Field

    At one thermal power project in Vietnam, inspection at source identified a dimensional discrepancy in the turbine casing before shipment, allowing the vendor to correct it before delivery. At another project in Bangladesh, expediting revealed that a sub-supplier was behind schedule on generator components, and early intervention prevented a delay to the overall delivery.

    Both cases show why inspection and expediting are most valuable when they happen early, at the vendor’s works, rather than at site.

    Non-Conformance Management

    Non-conformances are deviations from requirements. Managing them is critical.

    Non-conformance process:

    1. Identify: Identify the non-conformance.
    2. Document: Record the non-conformance in a non-conformance report (NCR).
    3. Assess: Assess the impact and severity.
    4. Disposition: Determine disposition (repair, rework, replace, accept as-is).
    5. Approve: Approve the disposition. Accept-as-is and repair dispositions should be approved by the engineer responsible and, where required, by the owner.
    6. Implement: Implement the disposition.
    7. Verify: Verify that the disposition was effective, with re-inspection where necessary.
    8. Close: Close the non-conformance.

    Non-conformances should be tracked and analyzed to identify trends and prevent recurrence. Repeated NCRs from the same vendor or the same sub-supplier may indicate a systemic problem that calls for a vendor quality audit or a corrective action plan.

    Shipping and Logistics

    Shipping and logistics ensure that equipment arrives at site safely and on time.

    Shipping and logistics activities:

    • Packing and preservation: Verifying that packing, marking, and preservation meet the specification, particularly for sea freight and long storage.
    • Shipping arrangements: Arranging transport from vendor to site, including heavy-lift and oversized cargo planning.
    • Customs clearance: Managing import/export procedures and documentation.
    • Insurance: Insuring goods during transport.
    • Tracking: Monitoring shipment progress.
    • Receiving: Inspecting and accepting deliveries at site, and recording any damage or shortages immediately.
    • Storage: Storing and preserving equipment in accordance with vendor instructions.

    Shipping and logistics should be planned to avoid delays and damage. Delivery terms (such as the applicable Incoterms) should be clear in the purchase order so that responsibility for risk, insurance, and customs is not in doubt.

    Using Third-Party Inspection and Remote Inspection

    Projects often use third-party inspection agencies, especially when vendors are located in many countries or when the owner’s own staff cannot attend every inspection. Third-party inspectors can provide local presence and specialized expertise, but they need a clear scope, the approved ITPs, and clear reporting lines. Remote inspection, using video, photographs, and electronic records, can supplement physical visits for lower-risk items or when travel is restricted, but it should not replace physical witnessing of critical tests.

    Vendor Inspection and Expediting in Small Plants

    Small plants face particular challenges with vendor inspection and expediting.

    Challenges:

    • Fewer resources for inspection and expediting.
    • Less expertise.
    • Less access to vendor facilities.
    • Competing priorities.

    Practical approaches:

    • Focus on critical equipment: Prioritize inspection and expediting for critical equipment.
    • Use third-party inspection: Leverage third-party inspectors for specialized work.
    • Use vendor information: Leverage vendor data and references.
    • Document everything: Good records support claims and disputes.
    • Train staff: Ensure staff understand inspection requirements.
    • Learn from others: Apply lessons from other projects.

    Vendor inspection and expediting do not need to be complex. They need to be thorough and consistent.

    Common Mistakes in Vendor Inspection and Expediting

    Even experienced organizations make mistakes. Common ones include:

    • No inspection plan: Inspection left to chance.
    • Inadequate ITPs: Inspection and test plans incomplete or not followed.
    • Skipping inspection: Accepting defective equipment.
    • Poor expediting: Discovering delays too late.
    • No progress reporting: Management not informed of vendor progress.
    • Ignoring sub-suppliers: Delays originating at sub-suppliers.
    • Releasing shipment before closing NCRs: Open non-conformances traveling to site.
    • Poor documentation: Records missing or incomplete.
    • No non-conformance management: Deviations not addressed.

    These mistakes are costly to correct. They are much cheaper to avoid through disciplined vendor inspection and expediting.

    How EPC Partners Inc. Approaches Vendor Inspection and Expediting

    At EPC Partners Inc., we bring practical experience from projects across Asia, the Middle East, Africa, and Europe to vendor inspection and expediting.

    Our approach includes:

    • Thorough planning: Inspection and expediting are planned from the beginning.
    • Detailed ITPs: Inspection and test plans are comprehensive and followed.
    • Disciplined inspection: Equipment is inspected before shipment.
    • Active expediting: Vendor progress is monitored closely.
    • Sub-supplier monitoring: Sub-suppliers are monitored for delays.
    • Detailed documentation: Records are complete and accurate.
    • Continuous improvement: Lessons are captured and applied.

    Our experience includes supporting geothermal projects in Kenya, Ethiopia, Indonesia, Iceland, and Japan; desalination projects in the UAE, Saudi Arabia, Oman, and Qatar; thermal power projects in Vietnam, Bangladesh, and Japan; and water treatment projects in Vietnam, Kuwait, and Qatar.

    We have also supported clients including Marubeni Corporation, Fuji Electric Co., Ltd., and Toyota Tsusho Corporation on vendor inspection and expediting aspects of their projects.

    How to Evaluate Vendor Inspection and Expediting Readiness

    When reviewing vendor inspection and expediting, ask:

    Question Why It Matters
    Is there an inspection plan? Provides a roadmap for inspection
    Are ITPs prepared and followed? Defines inspections and tests
    Are inspection levels appropriate? Balances risk and cost
    Is expediting in place? Ensures on-time delivery
    Is progress reported regularly? Keeps management informed
    Are sub-suppliers monitored? Prevents delays originating at sub-suppliers
    Are non-conformances managed? Addresses deviations
    Are shipping and receiving planned? Prevents damage and delay in transit
    Is documentation complete? Supports claims and warranty

    A project that addresses these questions is ready for effective vendor inspection and expediting.

    Key Takeaways

    • Plan inspection and expediting from the start, based on equipment criticality and risk.
    • Agree ITPs, hold points, and witness points with vendors before manufacturing begins.
    • Inspect at source; problems are cheapest to fix at the vendor’s works.
    • Verify progress physically and monitor sub-suppliers, where delays often begin.
    • Manage non-conformances to closure before releasing equipment for shipment.
    • Plan packing, shipping, receiving, and storage as part of the same process.
    • Keep complete records to support warranty and claims.

    Conclusion

    Vendor inspection and expediting are critical to plant success. For small to medium-scale industrial plants, they determine whether equipment arrives on time and meets specifications.

    By focusing on inspection planning, ITPs, inspection levels, expediting, kick-off meetings, progress reporting, inspection at source, non-conformance management, and shipping and logistics, owners and project teams can ensure that vendor inspection and expediting support the project throughout its life.

    If you are planning a plant project and need support with vendor inspection and expediting or EPC project delivery, contact us to discuss how we can help.

    EPC Partners Inc. is a Japanese EPC support firm with experience supporting power, water, and industrial plant projects across Asia, the Middle East, Africa, and Europe. For more information, visit our project list.
